Report for June 2017

Report Date
June 2017

IS Applications Infrastructure Programme Report for Programme Owner Stefan Keampf

Section One: Programme Commentary, RAG and Resources Update



Section Two: Projects Not Started Section Three: Projects In Progress Section Four: Closed or Withdrawn Projects

Section One: Programme Commentary, RAG and Resources Update

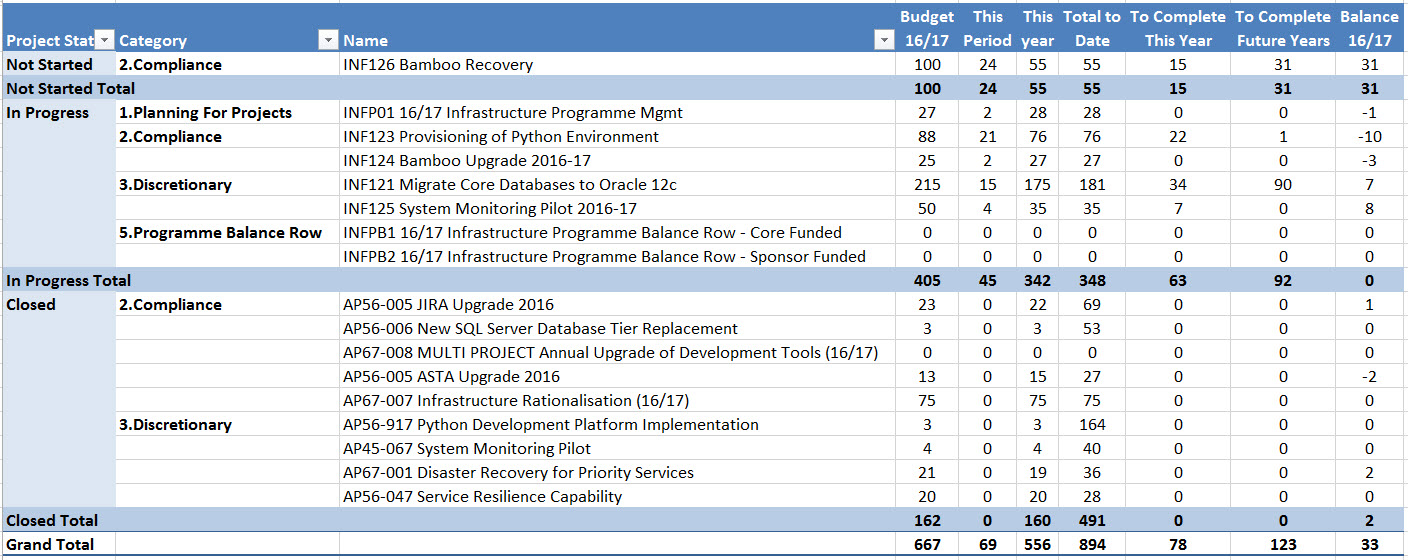

Overall Programme RAG: AMBER

All projects for 16/17 have now started.

The programme status is set as GREEN.







Section Two: Projects Not Started

Project Info Programme Manager's Commentary
  all projects started




Section Three: Projects in Progress



Project Info Project Manager's Commentary

INF121

Migrate Core Databases to Oracle 12c

Category: Compliance



Milestones

23-Jun-2017 GENDEV Post-migration Checks
28-Jun-2017 GenTEST post migration (integration) sign off
30-Jun-2017 Upgrade REPLive
10-Jul-2017 Upgrade TEST and LIVE environments to Oracle 12.2
21-Jul-2017 GenTEST Acceptance sign off
26-Jul-2017 GenLive deploy to LIVE

RAG Status / RAG change during last month

AMBER

Report by Chris Konczak for June 2017

Achievements this Period

  • Developer resource assigned to update connections and deploy bamboo changes if necessary and test
  • RMAN repositories for DEV / TEST and LIVE (required for backups) are in place and complete.
  • Upgrade DEV environment to 12.2 complete
  • Continuing investigations of what's required to migrate each application.



Issues

  • More application changes and interface information is coming to light after investigations on doing the actual data migration. This has taken longer than we originally thought and has impacted the actual migration of the applications to DEV.
  • DTI006 bookings have been assigned to the technical architect, but conflicts hadn't been addressed. The Technical architect will complete the migration to DEV and hand over to another to complete TEST. There has been a contractor employed with the relevant experience to take this on, and there is another person in the team who could also take this on.
  • Annual leave has delayed completing the DEV migration.

Next Steps

  • Agree and assign Technical Architect resource to continue with TEST and LIVE
  • Complete the DEV migrations
  • Post DEV migration testing
  • Migrate to TEST
  • Post TEST migration testing

RAG Commentary

Issue. Time is amber as the amount of work estimated to migrate GEN Dev is more than thought. Work continuing in identifying all schemas, however milestones will need to be revised. Handover required after DEV migration to another technical resource.



INF123

16-17 Provisioning of Python environment

Compliance

Milestones

Target Date

Title

22-Feb-2017

Iteration 1 Release

01-May-2017

Start of iteration 1A

08-May-2017

Start of iteration 2

12-May-2017

End of iteration 1A

18-May-2017

Start migration of IDM dashboard

05-Jun-2017

Start of iteration 3

07-Jun-2017

End of iteration 2

07-Jul-2017

End of iteration 3

14-Jul-2017

Delivery

28-Jul-2017

Closure



RAG Status

Red

Report by Chris Orrell for June 2017

Achievements in Last Period

  • Completed the replanning of the project following the loss of booked resources to HSS014. All iterations 3 deliverables should now be delivered in 16/17 with containerisation deliverables moved to 17/18.
  • Agreed a budget swap with HSS014 for 34 days.
  • D1.1 Custom Packaging for Edgel Innovation and D1.3 Improvements in Django Starter confirmed as delivered.
  • Started D1.4 Migration of IDM Dashboard as part of iteration 3. Python documentation is also progressing.
  • Nominated an application upon which to complete DR testing.

Issues

  • A budget swap was agreed with HSS014 but a question has been raised whether or not this project should be closed this year and a new project started when the organisation is ready to progress containerisation. Revised project milestones have not been proposed until this issue is resolved.

Next Steps

  • Confirm when the project is to close, update milestones and WIS accordingly.
    • it should be noted that if the project closes early due to the agile nature of the delivery this will not affect the deliverables that have already been achieved.


RAG Commentary

Change - Project milestones pushed back to reflect impact of diversion of resources to HSS014





INF125

System Monitoring Pilot 2

Discretionary

Milestones

14-Jul-2017 Requirements document (base for next year’s procurement) (WIS)
21-Jul-2017 Closure (WIS)



RAG Status

GREEN



Report by Maurice Franceschi for June 2016

Achievements in Last Period

  • checking requirements against AppDynamics and capturing feedback on shared xls - using EUCLID and UWS - started
  • hold workshop to identify business processes to be monitored and how to configure these in the system - achieved

Issues and Risks

  • no amber or red risks

Next Steps

  • complete UAT - checking requirements against AppDynamics and capturing feedback on shared xls - using EUCLID and UWS
  • confirm requirement set for future procurement
    • closure



INF126

Bamboo Recovery

Compliance

Milestones

01-Aug-2017 No date available sign off complex updates
01-Sep-2017 No date available sign off MyED updates
18-Sep-2017 No date available End of encryption investigation
02-Oct-2017 No date available Project closure

Report by Maurice Franceschi for June 2016



Achievements in Last Period

  • confirm funding - achieved
  • project approved - achieved

Issues and Risks

  • Project Brief to be approved

Next Steps

  • confirm funding
  • confirm project manager
  • start re-planning
  • submit brief to WIS again



Section Four: Closed or Withdrawn Projects



Project Info Project Managers Commentary
INF115 Python Development Platform Implementation Closure Approved August 2016

INF113 (AP45-067)

System Monitoring Pilot

Closure Approved 16 September 2016

INF111 (AP56-006)

New SQL Server Database Tier Replacement

Closure Approved 30 September 2016

INF118

JIRA upagrade 2016

Closure  Approved 30 September 2016

INF120

Disaster Recovery for Priority Services

Closure Approved 3 March 2017

INF116

ASTA Upgrade 2016

Closure Approved 3 March 2017

INF122

Infrastructure Rationalisation

Closure Approved 1 May 2017

INF124

Bamboo Update 2016

Closure Approved  expected 7th July 2017

INF119

Service Resilience Capability

Closure Approved 18 June 2017
