August 2016

Report Date
August 2016

IS Applications Infrastructure Programme Report for Programme Owner Stefan Keampf

Section One: Programme Commentary, RAG and Resources Update

Section Two: Projects Not Started

Section Three: Projects In Progress

Section Four: Closed or Withdrawn Projects



Section One: Programme Commentary, RAG and Resources Update

Overall Programme RAG: AMBER

The contingency has already been applied to a number of 15/16 projects to balance bdugets and enable their completion this year.

A general slippage across all projects is disappointing but we expect to see the programme delivering most of its benefits by December.























Section Two: Projects Not Started

Project InfoProgramme Manager's Commentary
Implement Environment Monitoring SolutionThis is unlikely to proceed, at least as it had been expected. A scoping / gap analysis exercise may  be undertaken.
Annual Upgrade of Development ToolsWith the unplanned projects from last year using up this bduget, unlikely we will upgrade in 16/17.
Provisioning of the Python EnvironmentStarting this a mnth early, in September.



Section Three: Projects in Progress



Project InfoProject Manager's Commentary

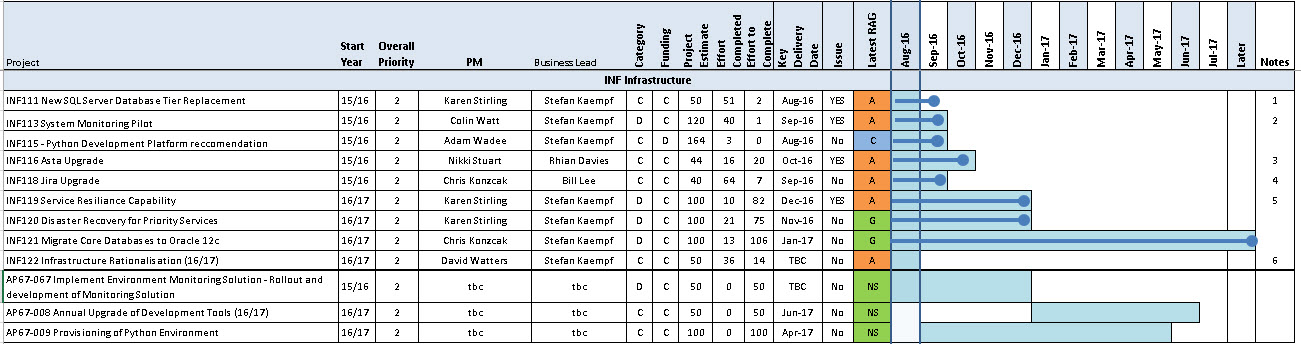

INF111 (AP56-006)

New SQL Server Database Tier Replacement

Category: Compliance



Milestones

30-Sept-2016Closure











RAG Status/ RAG change during last month

Project status is AMBER

Report by Karen Stirling for August 2016



Achievements in Last Period

  • Project Completion report drafted and issued out for review by project sponsor and programme manager

Issues

  • Expectation that the new TAD would be drafted and available to ITI for review and acceptance unfortunately Dev Tech resource has been on leave and now booked on other projects. This has been raised to the appropriate resource manager for them to confirm availability as soon as is possible.
  • Closure milestone to be moved out awaiting delivery of TAD and completion report sign off

    Next Steps

  • Closure sign off
  • WIS Approval to close

 The project current status is AMBER as awaiting Dev Tech resource to complete TAD documentation to allow project to close





INF113 (AP45-067)

System Monitoring Pilot

Category: Discretionary



Milestones



29-Aug-2016Recommendations
09-Sep-2016Close



RAG Status / RAG change during last month

AMBER

Report by Colin Watt for for August 2016



Achievements in Last Period

  • Recommendations Report distributed and feedback incorporated.
  • Closure report drafted.



Issues

  • Some disagreement on wording of report re: objectives and recommendations; Project Sponsor has given PM steer on how to reword to resolve this and has communicated intentions to colleagues in ITI.



Next Steps

  • Distribute closure report and incorporate feedback.
  • Project Closure.



The project current status is AMBER due to delay on agreeing recommendations report and closure.

INF116 ASTA Upgrade 15/16

C

Milestones

09-Sep-2016Testing Complete
23-Sep-2016LIVE Upgrade Complete (Deployment)
07-Oct-2016Deployment Sign Off
14-Oct-2016Project Closure

RAG Status

AMBER

Report by Nikki Stuart for August 2016



Achievements:

  •  UAT started
  • Test issues resolved
  • Provisional LIVE dates agreed
  • Initial comms to users issued

Issues:

  •  OPEN - There is an oustanding issue that may delay the LIVE upgrade (see INF116 JIRA 1). In testing the application is taking around 1.5mins to open and the cause of this needs to be understood to determine if this is behavour that can be resolved or discuss if this could be acceptable to users.

Next Steps:

  • Complete UAT
  • Discuss and agee LIVE dates with ASTA
  • complete LIVE upgrade
  • Update the timesheet to https



Status

Project status has been set to AMBER as the project has been replanned in the last month (resolved) and there is an outstanding issue that needs to be resolved to allow remaining milestones to be met (open).



INF118 (AP56-005)

JIRA Upgrade 2016

Category: Compliance



Milestones

16-Sep-2016Deployment Sign Off Review
23-Sep-2016Closure



RAG Status / RAG change during last month

AMBER





Report by Chris Konczak for August 2016



Achievements in Last Period

  • UAT signed off
  • JIRA deployment completed to LIVE with no issues reported



Issues

  • No Issues
  • Project is AMBER (Resolved) this month as the delivery date has been brought forward from 05/09/16 to 25/08/16 due to infrastructure license expiring.



Next Steps

  • Deployment sign off review
  • Closure to complete in September



The project current status is AMBER (Resolved).

INF119 (AP56-047)

Service Resilience Capability

Category: Discretionary



Milestones

30-Sept-2016

Review of Top & Medium Priority Services

TBC

Priority Service (1) Development Failover complete

TBC

Priority Service (1) Test Failover complete

TBC

Priority Service (2) Development Failover complete

TBC

Priority Service (2) Test Failover complete

TBC

Priority Service (2) Live Failover complete

05-Dec-2016

Delivery

16-Dec-2016

Closure



RAG Status / RAG change during last month

AMBER

Report by Karen Stirling for August 2016

Achievements in Last Period

  • Initial review of Top and Medium Priority Services completed for Service resilience e.g full, partial or none - this needs to be reviewed and confirmed by Dev Tech resource

Issues

  • Project team are looking to use another potential candidate application (e.g. Wiki) as this is not held on AppsLive, need to review with Service Manager as WIKI Upgrade project COM026 is due to sign off Deployment Review milestone before we consider planning any activity on project
  • Project milestones to be reviewed and revised removing any milestones no longer relevant
  • Forecasted resource budget in 15/16 of 25 days not fully used therefore may require additional effort in 16/17. This will be re-estimated on completion of first failover application.
  • Project Sponsor has asked if we can consider additional scope of testing SRM resilient file solution ITI have put in place.

Next Steps

  • Request a review of SRM soution from ITI to consider if this can be included in scope of project
  • Plan Wiki failover activity for Dev



The project status is AMBER due to change of application to test and milestones to be reviewed and agreed

INF120

Disaster Recovery for Priority Services

Category: Discretionary



Milestones



30-Sept-2016DR Document Storage Area ready
21-Oct-2016Priority Services DR Documentation complete
14-Nov-2016Delivery
02-Dec-2016Closure



RAG Status / RAG change during last month

GREEN

Report by Karen Stirling for August 2016



Achievements in Last Period

  • All priority services information reviewed and updated in dashboard
  • Component workflows created for each service
  • Agreement gained for project touse IS Applications Sharepporint site to upload TADs and DR information, engagement with Service Management
  • Draft Structure created for SharePoint - this has been distributed to project team for consideration and agreement
  • Meeting held with Graeme Wood ITI regarding INF120 project reviewing our project progresss and activity, and how this may assist /dovetail with ITI Business Continunity Project

Issues

  • Consider if new TAD versions should be reproduced for 5 priority services
  • DR repository has still to be created - waiting for confirmation TADs can be uploaded onto SharePoint Site - Project Sponsor proposing this to OGG, also Service Management resource availability to support repository creation. Extending milestone date for delivery however this does not impact key delivery milestone.

Next Steps

  • Review DR plans and identify any potential gaps of information
  • Review previous DR documentation and create new updated versions for review and agreement
  • Review project resource estimates, returning potential unused days back to programme



The project status is GREEN

INF121

Migrate Core Databases to Oracle 12c

Category: Compliance



Milestones

30-Sep-2016Systems Analysis and design complete
06-Oct-2016DEV environment build for NewsLive complete
28-Oct-2016Build sign off for NewsLive
04-Nov-2016Test environment build for NEWSLive complete
23-Nov-2016NewsLive Integration Sign off
09-Dec-2016NewsLive Acceptance sign off
22-Dec-2016Live environment build for NewsLive complete
11-Jan-2017NewsLive deploy to LIVE
25-Jan-2017NewsLive Deployment sign off
31-Jan-2017Re-estimation for GenLive



RAG Status / RAG change during last month

GREEN

Report by Chris Konczak for August 2016



Achievements this Period

  • Brief signed off by WIS
  • Analysis work commenced on NEWSLive



Issues

  • None



Next Steps

  • Continue analysis work on NewsLive
  • TAD and TAD reviews to be completed
  • Creation of DEV environment to begin for NEWSLive



The project status is GREEN



INF122

16 - 17 Infrastructure Rationalisation

Category: Compliance



Milestones

23-Sep-2016Planning sign-off

RAG Status / RAG change during last month

AMBER

Report for August 2016 by David Watters



Achievements in Last Period

  • DRPS (Test & Live) migrated to new servers
  • LSA & CF servers decommissioned
  • MIS Buffy cleared down ahead of decommission

Issues and Risks

  • Some migrations have been more complex than anticipated
  • Finalisation of brief delayed because of effort required on outstanding migrations

Next Steps

  • Complete & sign-off project brief
  • Prepare report on applications/servers for inclusion in annual planning



Project status is AMBER because of need to change planning milestone.





Section Four: Closed or Withdrawn Projects



Project InfoProject Managers Commentary
INF115 Python Development Platform ImplementationClosure approved August 2016
