Report for May 2018

Report Date
May 2018

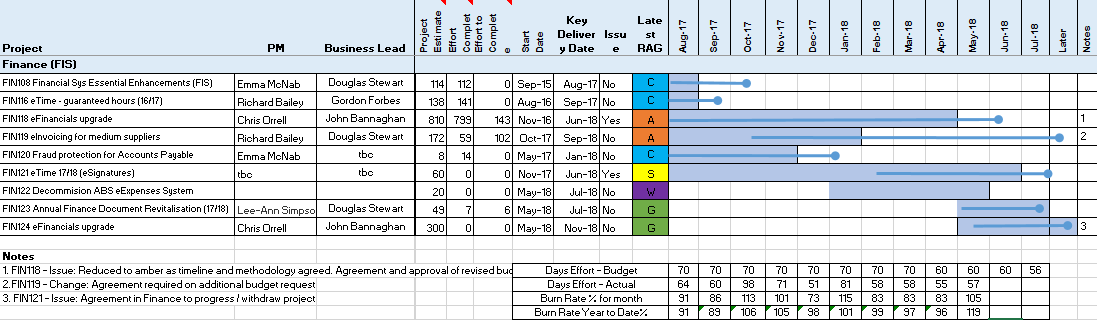

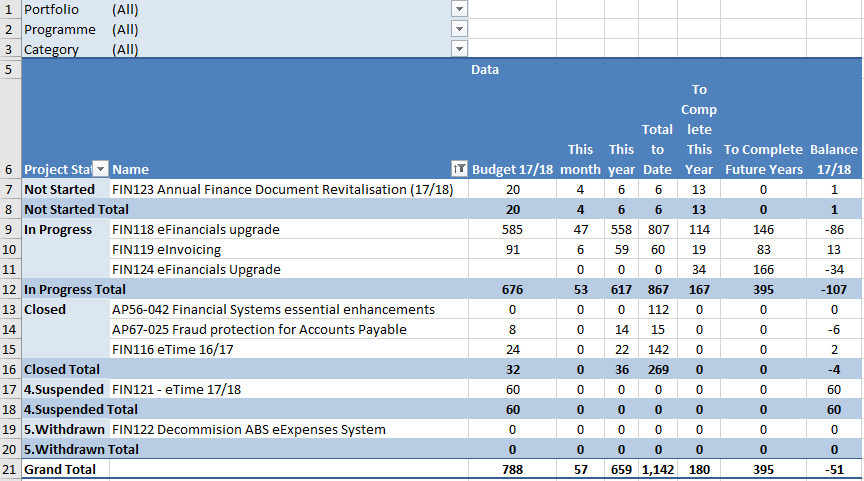

Resource Position

The resource position does not reflect current discussions on required changes for:

  • FIN118: Project to be closed and budget to complete the upgrade this year and next is to be moved to FIN124.
  • FIN119: The transfer of budget from Procurement Programme to cover additional Core budget requirement.  This will increase budget this year to 116 days.
  • FIN123: This project is due to complete planning with an increased estimate of 49 days for the project this year.
  • FIN124: Core / Sponsor Funded (tbc) budget to progress project to closure - see FIN118

The above will be reflected in the June Resource Position.

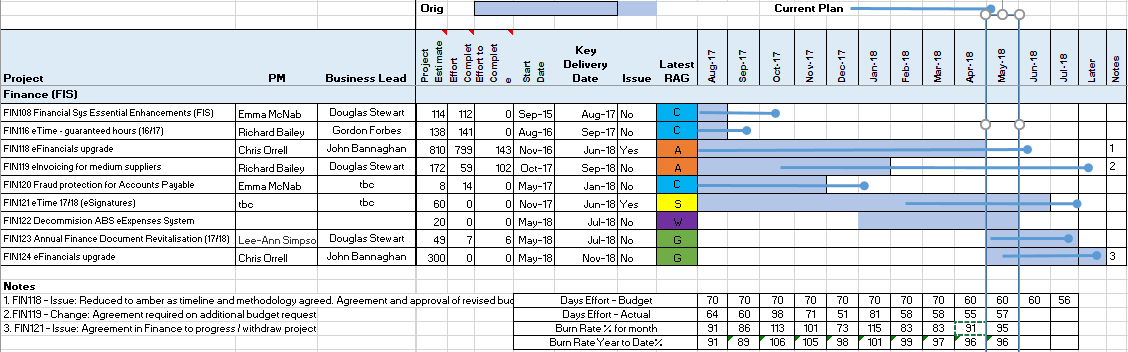

Forward Look

Section 2: Projects Not Started

Project Info Programme Managers Commentary

FIN121

eTime 17/18 (eSignature)

Planning - tbc

Delivery - tbc

 RAG Status : Amber

 Currently suspended - to be closed.

FIN124

eFin Upgrade

Planning - tbc

Delivery - tbc

 RAG Status : Green

Project FIN124 has been opened to replace FIN118 to:

  • Ensure clarity on remaining work not specifically related to the database version issues
  • Avoid having a project with two sets of milestones, two briefs etc
  • Enable a full review of current project risk and issue logs to ensure we carry over only those risk and issues relevant to the remaining work
  • Provide greater clarity to stakeholders on the costs, risks and issues going forward
  • Enable a closure report and gateway review on the original project for lessons learned etc

The closure report for FIN118 and development and sign off for FIN124 brief will be completed in June 2018.





Section 3: Projects in Progress



Project Info Project Managers Commentary

FIN118 (AP56-016)

eFinancials upgrade

Core funded

Expected milestones across the closure of FIN118 and opening of FIN124:

Target Date

Title

25-May-2018

End of Re-planning (FIN118)

29-Jun-2018

End of DEV / sign-off - Repeat (FIN124)

16-Jul-2018

UAT available to repeat (FIN124)

26-Oct-2018

Readiness / Approval to Go-Live (FIN124)

12-Nov-2018

Go-Live (FIN124)

30-Nov-2018

Deployment Sign-off

14-Dec-2018

Project Closure



RAG Status: Amber



Report by Chris Orrell

Report Date - May 2018

Achievements in Last Period

  • It has been agreed with the Project Sponsor, IS Senior Management and supplier that the project should target a go-live of November 2018.
    • Against this decision a revised project plan has been prepared and reviewed by the project team.
    • Three point estimate has been prepared and signed off by the project team.
    • Against the new estimate to complete the project, resource requests for the full project have been requested.
  • Security Pen Testing for Supplier Self Service has been completed and a full report issued. The report has been shared with key stakeholders / supplier.
  • TEST and Pre-LIVE have been upgraded to eFinv5 Oracle 12.1.
  • Repeat DEVv5 interface testing has started and is currently at 43% passed with 1 failed test from 25 tests completed so far.

Issues

  • Impact to Budget and Timeline due to TEST & Pre-LIVE being rebuilt to Oracle 12.1, interface testing being repeated for DEV & TEST and Finance repeating all of UAT.
  • Revised budget has yet to be agreed but agreement is expected immanently.
  • Outstanding actions to be resolved with Supplier (see issues / meeting log). Next meeting planned for June 5th.
  • Outstanding JIRAs.

Next Steps

  • A decision to close FIN118 and open a new project to take the upgrade forward (FIN124) was agreed at WIS.  An update is to be provided to Senior Stakeholders outlining the benefits of this including provision of greater clarity on the costs, risks and issues going forward.
  • Closure report for FIN118
  • Development and sign off for FIN124 brief
RAG Commentary
Amber: Issue: Reduced from red to amber as timeline and methodology agreed. Agreement and approval of revised budget and actions with supplier remain outstanding.

FIN119 (AP67-024)

eInvoicing



Target Date Title
22-Jun-2018   Complete Analysis (Process Mapping / Applications and Data Architecture (ADA) Document / Suppliers Identified)
29-Jun-2018 Phase 2 – Create work packages / discrete backlog items
05-Oct-2018 Development & Deployment of the API / XML Handler
12-Oct-2018 On-board the First 3 Suppliers
19-Oct-2018 On-board the Second 5 Suppliers
24-Oct-2017 Phase 2 – Deployment sign off
02-Nov-2018 Project closure



RAG Status : AMBER



Report by Richard Bailey

Report Date
May 2018

For reference:  SG = Scottish Government,  SGS = Scottish Government Solution

Achievements this Period

  • New Project Proposal drawn up to be confirmed / agreed with the Project Sponsor / Stakeholders, formulated after negotiation with the SG

Issues

Next Steps

  • Ongoing review and update of  risks and proposed remedial actions.
  • SR document agreed and sign off / Formal engagement with the SG.
  • Plan the subsequent WPs
  • Complete the Applications and Data Architecture (ADA) Document and achieve sign off.

RAG Commentary

Change: The change to the project timescales and moving a proportion of the development to the 2018-19 Financial Year creates a risk around securing budget to complete the tasks required in that year as budgets for 2018-19 are not yet agreed / set.



FIN123 (AP56-016)

Annual Finance Document Revitalisation 17/18

Target Datesort descending Previous Date Title Stage Complete
01-Jun-2018 No date available Planning (Major) Plan Yes

view

08-Jun-2018 No date available Business Analysis Completed Analyse No

view

15-Jun-2018 No date available Advanced System Design Completed Design No

view

22-Jun-2018 No date available Advanced Build Complete Build No

view

29-Jun-2018 No date available IS Integration Complete Integrate No

view

06-Jul-2018 No date available Acceptance Testing Complete Accept No

view

13-Jul-2018 No date available Deliver to Operation (Major) Deliver No

view

27-Jul-2018 No date available Project Closure (Major) Close No

view

Core funded



RAG Status : GREEN

Report by Lee-Ann Simpson

Report Date
May  2018

Achievements

  • Completed planning for the project which was signed off by WIS on Friday 1st June.
  • Project brief signed off by all stakeholders to allow this to be passed via WIS for end of planning.
  • System Design commenced and BRD created.
  • Initial 'As Is' training commenced.

Issues

  • 'As Is' and 'To Be' testing impacted by end of month reporting.

Next Steps

  • Changes scheduled to be undertaken on the 12th June by Supplier with a follow up session scheduled for 20th June.


Section 4: Closed or Withdrawn Projects



Project Info Project Managers Commentary

FIN116 (AP67-022)

eTime - guaranteed hours

Category: Discretionary

Project Manager - Richard Bailey

Project closed 15th September 2017

Completion Report

FIN117 (AP56-054)

Finance BI Improvement

Category: Discretionary



Project Manager - Richard Bailey

Project closed 4th August 2017

Completion Report

FIN108 (AP56-042)

Essential enhancements (FIS)

Category: Discretionary

Project Manager - Emma McNab

Project Closed 6th October 2017

Completion Report

FIN 120 (AP67-025)

Fraud protection for Accounts Payable

Category: Discretionary

Project Manager - Emma McNab

Project Closed 12th January 2018

Completion Report

FIN122

Decommissioning ABS Expense System

Project Manager - Emma McNab

Project Withdrawn 2nd February 2018
