Organisation

Work/Task Breakdown

See Project Plan

Resources and Skills

Workshops
  • Facilitator – Review of workshop brief and session plans, running workshop

    • External facilitator,
  • Project Manager – Annie Heaney
  • Research Lead – Jill MacKay, assistance with workshop planning and synthesis of outputs
  • Admin – To be found within ISG, Room booking, invites, note taking, follow up
  • IAD – participation in session
  • Academic User Group - attendance at sessions, assistance with securing appropriate academic and student attendance, participation in final AUG workshop to synthesize results of individual School sessions

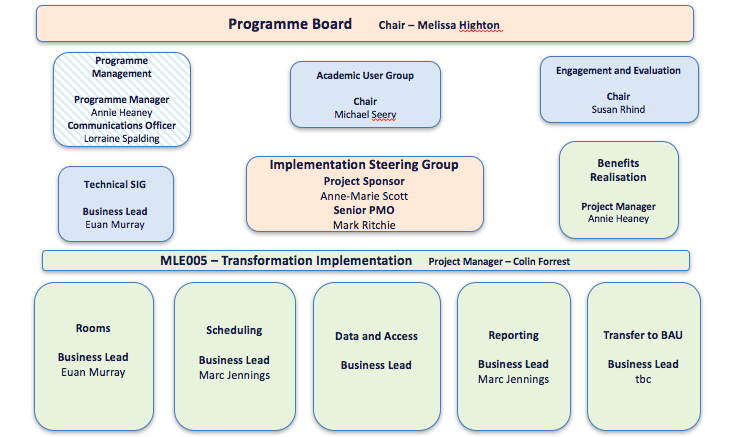

Project Governance

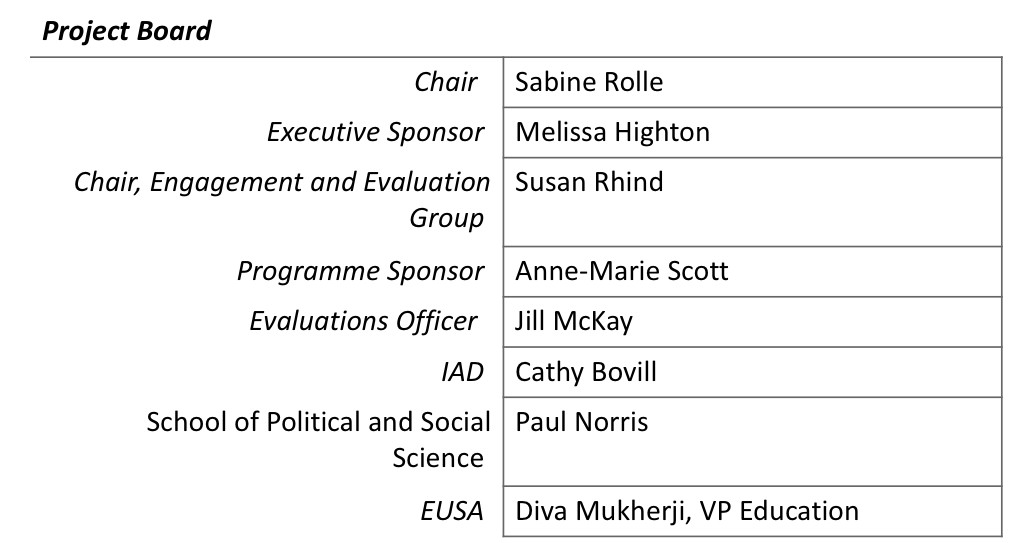

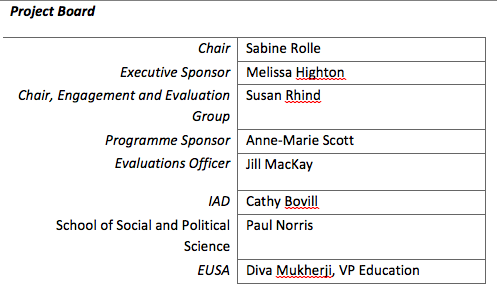

Project Board

The Project Board will:

  • Ensure that overall goals of the Project, set by the Engagement and Evaluation Group, are met.
  • Resolve any issues raised by the project team.
  • Receive updates from the Project Manager and report on progress to the Engagement and Evaluation Group
  • Approve the completion report and the lessons learned report for the Project.
  • Ensure information about the project is effectively communicated to the organisation and stakeholder groups as necessary.

Project Manager and Comms Officer to attend meetings

Project Duration and Frequency of Meetings

The project will be set up for the start of Semester 2, 2018/19 and will remain open through to the end of Semester 1, 2019/2020 to oversee the delivery of the guidelines for the use of the service and reporting on the initial benefits realized by the introduction of the service.

At this point, the need for the work of the project to continue will be reviewed.

The Project Board will initially meet bi-monthly, starting in January 2019, to oversee the work carried out to plan delivery of project goals and deliverables.

Project Info

Project
Lecture Recording Benefits Realisation
Code
MLE006
Programme
ISG - Lecture Recording (MLE)
Management Office
ISG PMO
Project Manager
Annie Heaney
Project Sponsor
Melissa Highton
Current Stage
Close
Status
Closed
Project Classification
Transform
Start Date
26-Jan-2019
Planning Date
26-Feb-2019
Delivery Date
12-Aug-2019
Close Date
27-Sep-2019
Programme Priority
3
Overall Priority
Normal
Category
Discretionary

Documentation

Plan
