April 2015
- Report Date
- April 2015
Report compiled by Maurice Franceschi, (IS Apps Programme Manager) for Mark Wetton and Anne-Marie Scott
Section One: Programme Commentary, RAG and Resources Update
Section Two: Projects Not Started
Section Three: Projects In Progress
Section Four: Closed or Withdrawn Projects
Section One: Programme Commentary, RAG and Resources Update
Overall Programme RAG: GREEN
The programme has a large number of ('Apps') projects reflecting the activity and expectations being generated in the TEL area. Amongst its challenges and opportunites, there is the new LTW division and changes in the way of working and relationships with rest of IS which that will bring. So an exciting time.
All projects now back to Green, but we have concerns that we have several projects all now delivering at the same time in June and July. However, at this point we keep the status as Green as the project managers and LTW are committing to closures as stated.
The programme has 60 days for contingency and to - hopefully - start the 15/16 data feeds for moodle project.
IS Applications Projects

USD Projects
Planning not in place.
IS Applications Budget

Section Two: Projects Not Started
| Project Info | Project Manager's Commentary |
| Working with APPS | |
| all project which were planned now started/completed. We will assess the potential for an in-year moddle data feeds project, in March. | |
| LTW Projects | |
| VLE STudent Analytics - Moodle | TEL019 |
| ePortfolio Gap Analysis | |
| TAG Assessment Tools | |
| TREE | TEL020 |
| Also note there are two other projects of interest to TEL | Multimedia Procurement and Multilemedia Implementation - Major Projects being delivered by the separate Multimedia Programme, but which will be services supported by TEL once delivered. |
Section Three: Projects in Progress

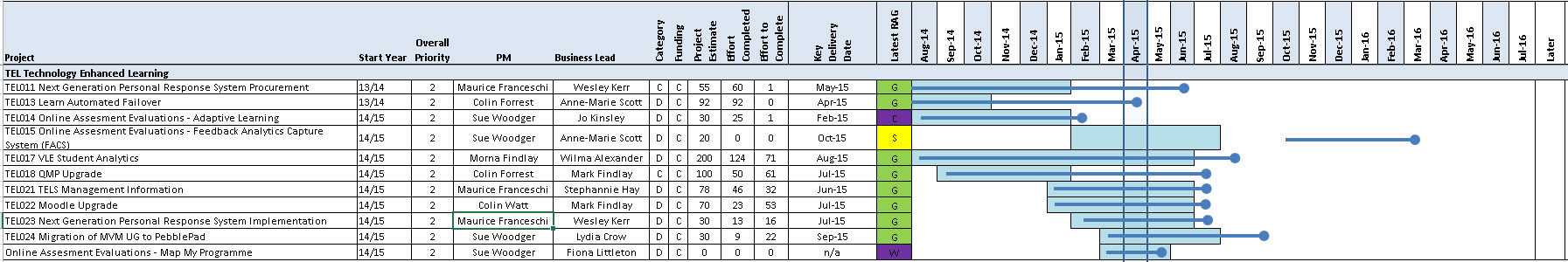

| Project Info | Project Manager's Commentary | |||||||||||||||||||||||||||||||||||||||||||||||||
Next Generation Personal Response System (PRS) - ProcurementCompliance
Milestones
RAG Status GREEN | Report by Maurice Franceschi for April 2015Top Hat have been awarded the contract. However, the T&C's now have to be written up.The SLA from Top Hat was unsatisfactory, so an SLA will be drafted by UoE. Achievements in Last Period
Issues
Next Steps
| |||||||||||||||||||||||||||||||||||||||||||||||||
Learn Automated Failover Milestones
RAG Status GREEN | Report by Colin Forrest for April 2015Achievements in the Last Period
Issues
Nest Steps
| |||||||||||||||||||||||||||||||||||||||||||||||||
Online Assessment/Feedback Evaluations – FACS Milestones:
RAG Status
SUSPENDED
| Report by Sue Woodger for April 2015TEL015 suspended for 6 months until 1 October 2015.
Next StepsEnd of Suspension 1 Oct 15
| |||||||||||||||||||||||||||||||||||||||||||||||||
VLE Student Analytics Milestones
RAG Status GREEN | Report by Morna Findlay for April 2015
Issues
Next Steps
The project RAG status is GREEN | |||||||||||||||||||||||||||||||||||||||||||||||||
QMP Upgrade Milestones:
RAG Status GREEN | Report by Colin Forrest for April 2015Achievements in the Last Period
Issues
Nest Steps
| |||||||||||||||||||||||||||||||||||||||||||||||||
TELS Management InformationDiscretionary
Milestones
RAG Status GREEN | Report by David Watters for April 2015
Achievements in Last Period
Issues
Next Steps
| |||||||||||||||||||||||||||||||||||||||||||||||||
Moodle Upgrade Compliance
Milestones
RAG Status GREEN | Report by Colin Watt for April 2015Achievements in Last Period
Issues
Next Steps
| |||||||||||||||||||||||||||||||||||||||||||||||||
Next Generation Voting System Implementation Compliance
Milestones
RAG Status GREEN | Report by Maurice Franceschi for April 2015
Achievements in Last Period
Issues
Next Steps
| |||||||||||||||||||||||||||||||||||||||||||||||||
TEL024 Migration of MVM UG to PebblePad Discretionary Milestones
RAG Status GREEN
| Report by Sue Woodger for April 2015
Achievements
Issues
Next Steps
|
Section Four: Closed or Withdrawn Projects
| Project Info | Project Managers Commentary |
Online Assessment/Feedback Evaluations - Adaptive Learning | Project closed 27 April 15 |
