Report for November 2017

Report Date
November 2017

IS Applications Infrastructure Programme Report for Programme Owner Stefan Kaempf

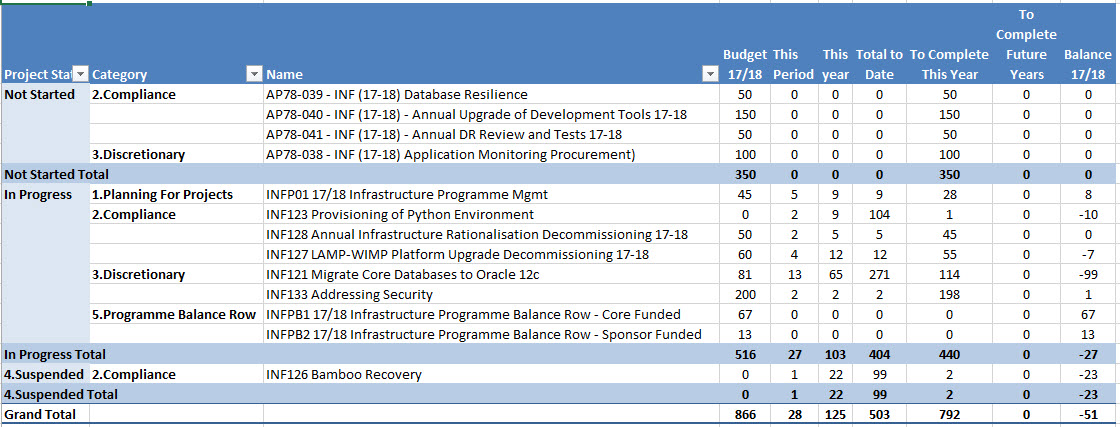

Section One: Programme Commentary, RAG and Resources Update

Overall Programme RAG: AMBER

The programme status is set as AMBER as we have significant unplanned resource for INF121 (in particular) and INF123,INF126 that removes our contingency completely.

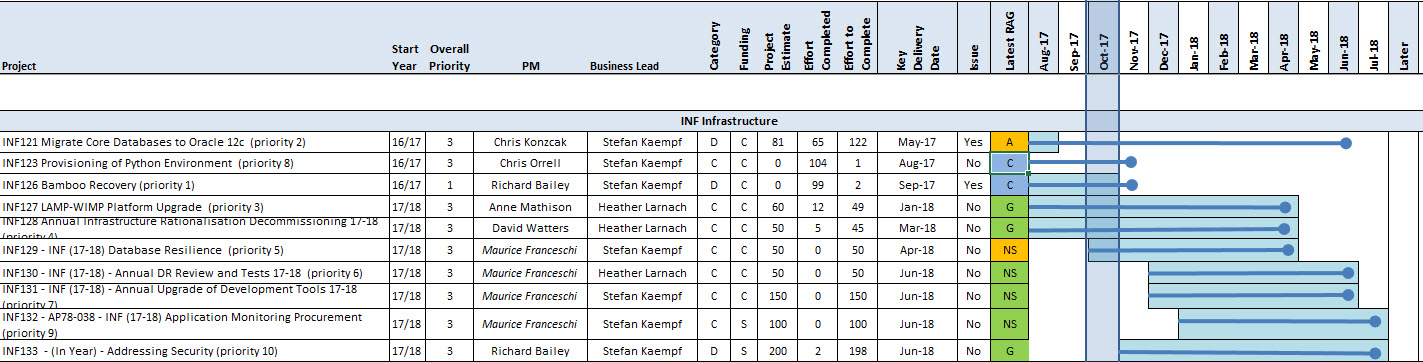

Section Two: Projects Not Started

Project Info Programme Manager's Commentary
INF130 - INF (17-18) - Annual DR Review and Tests 17-18 Planned to start December 2017, Priority 6
INF131 - INF (17-18) - Annual Upgrade of Development Tools 17-18 Planned to start December 2017, Priority 7
INF132 - INF (17-18) Application Monitoring Procurement Withdrawn November 2017



Section Three: Projects in Progress



Project Info Project Manager's Commentary

INF121

Migrate Core Databases to Oracle 12c

Category: Compliance



Milestones

19-Jan-2018 GenTEST post migration (integration) sign off
05-Feb-2018 GenTEST Acceptance sign off
13-Feb-2018 GenLive deploy to LIVE
27-Feb-2018 GenLive deployment sign off
27-Feb-2018 Begin News 12.2 migrations



RAG Status / RAG change during last month

RED

Report by Chris Konczak for November 2017

Achievements this Period

  • Progress continues on enabling the Bamboo plans. Developers continuing to work and document on this.
  • Dev Tech continuing to set up GEN TEST environment in preparation for the migrations.



Issues

  • On review of budget requirements, APPS migrations will not be done in 17/18. A proposal will be submitted for 100/150 days in 2018/19.
  • Scope change agreed and to be recorded to include the upgrade of News from Oracle 12c to Oracle 12.2
  • Budget change to allocate 50 days for 2017/18 to complete GEN and NEWS 12.2 upgrade.
  • Issue with applying the Oracle 12.2 upgrade to GEN LIVE meant the upgrade could not continue. Oracle DB Upgrade Assistant – used to perform the upgrade – failed to launch. Oracle eventually provided a solution to this which is to install the dejavu fonts package on the server. Now tested and working. This upgrade now needs to be rescheduled.



Next Steps

  • GEN Dev environment completed and documented
  • LIVE environment to be upgraded to 12.2 ahead of the planned migrations. The only application on LIVE is Bamboo.
  • Project to be replanned to complete GEN and NEWS 12.2 upgrade in 2017/18. APPS migrations to be removed and replanned for 2018/19.





RAG Commentary

Change - Scope RED as change required to migrate NEWS from Oracle 12c to Oracle 12.2. Budget change required to complete GEN migration and additional NEWS 12.2 scope. Time red as a result of change of scope and the extra effort required for GEN migrations. Revised budget and plan has been approved by Programme Manager and Owner, and will be actioned w/c 11 December, no action from SMT required.





INF127 (AP78-044)

LAMP / WIMP Platform Upgrade

Milestones

Date Milestone
14-Feb-2018 Set up New Platform
23-Feb-2018 Produce LAMP/WIMP findings on current platform
23-Mar-2018 Acceptance Test of Platform
19-Jan-2018 Deploy New Platform
13-Apr-2018 Close

RAG Status

RED



Report by Anne Mathison for November 2017

Achievements :

Platform progress

  • Servers are in place
  • Passwords set up
  • Configured puppet
  • Ready for puppet code when it is handed over
  • Established SSP contacts for testing PATH in Test
  • Added SSP business contacts as stakeholders

Issues

  • A resource conflict with the Unidesk Annual Upgrade project has resulted in the milestones being replanned and agreed (referred to in PICCL 4)

Next Steps :

  • Look into RISK 7 re End Of Live YII to see what progress can be made
  • Little other progress until Mid January
  • Start on setting up new platform, delayed to be completed in February
  • Set up new Platform in the environments (Dev, Test and Live), delayed to be completed in February
  • Review and update draft of LAMP/WIMP findings on current platform, delayed to be completed in February

RAG Commentary

Change - Due to a resource conflict with the Unidesk Annual Upgrade project (SMI018), the milestones have been replanned and agreed with the Project Sponsor and Programme Manager. The project is now planned to deliver the new infrastructure in April 2018 (was previously January 2018).

INF128

Annual Infrastructure Rationalisation Decommissioning 17/18

Milestones

30-Nov-2017 Updates to Portfolio/Programme Managers Analyse
08-Feb-2018 Checkpoint for outstanding migrations Deliver
30-Mar-2018 Migrations completed/planned Deliver
13-Apr-2018 Project closure Close



RAG Status

Green

Report by David Watters for November 2017

Achievements

  • EOL Register updated for 17-18
  • Sharepoint site established
  • Listings passed to managers in Applications Management

Issues

  • None

Next steps

  • Work on registers of equipment & applications to continue
  • Any urgent items to be reported to Portfolio/Programme Managers

INF129 Database Resilience 17-18





Milestones

Target Datesort descending Title
No date available Project Execute complete
No date available Project Delivery complete
No date available Project Close complete
No date available Project Analysis complete
No date available Project Design Complete
No date available Project Build Complete
No date available Project Integration complete
No date available User Acceptance Testing Complete
15-Dec-2017                           Planning Complete





RAG Status

AMBER



Report by Megan Graham for November 2017

Achievements This Period

  • Project Planning in Progress
  • Project 'kick-off' Meeting arranged for 14th December.
  • Project risk meeting with WIKI team arranged for 18th December by Programme Manager.
  • Project Brief in Progress.
  • Issues

  • Possible delay in Planning Milestone completion due to late arrival of PM resource and availability of key stakeholders.

Next Steps

  • Complete Brief

  • Clarification of the WIKI application Upgrade Project, impact on the Project.

INF133

Addressing Security

Milestones

To be agreed at WIS 03/11/2017

Target Datesort descending   Title
10-Nov-2017 End of Planning
26-Jan-2018 Phase 1 - Workshops / analysis completed
02-Feb-2018 Phase 1 – Deliverables sign off
09-Feb-2018 Phase 2 – Work-packages agreed, estimate confirmed and signed off
01-Jun-2018 Phase 2 – Work-package completion
08-Jun-2018 Phase 2 – Deploy
15-Jun-2018 Phase 2 – Deployment sign off
06-Jul-2018 Project Closure

RAG Status

GREEN



Report by Richard Bailey for November 2017

Achievements this Period

  • Project was submitted to WIS for approval  03/11/2017
  • Required resource secured
  • 4 research workshops planned, starting 29/11/2017 and ending 10/01/2018, to analyse / determine the delivery pipeline
  • A draft design document has been initiated
  • Issues

  • None
  • Next Steps

    Please note these go through and beyond December into January

  • Continue / complete research workshops
  • Prepare documentation / complete the design document
  • Plan recommendations / work packages required and circulate to stakeholders
  • Hold a review meeting with key stakeholders to present findings and look to secure sign off against proposed recommendations and work packages







Section Four: Closed or Withdrawn Projects



Project Info Project Managers Commentary

INF123

16-17 Provisioning of Python environment



INF126

Bamboo Recovery
