October 2015

Report Date
October 2015

IS Applications Infrastructure Programme Report for Programme Owner Stefan Keampf

Section One: Programme Commentary, RAG and Resources Update

Section Two: Projects Not Started

Section Three: Projects In Progress

Section Four: Closed or Withdrawn Projects



Section One: Programme Commentary, RAG and Resources Update

Overall Programme RAG: GREEN

The programme main projects for first half of the year all under way, with planning phase taking longer for some than had been expected. Budgets fine.















Section Two: Projects Not Started

Project InfoProgramme Manager's Commentary

System Monitoring Solution - Pilot



INF107 having completed, the next project will split into a Pilot phase to validate the technical solution and the process changes recommended, before procurement/implementation.

We had hoped to start this in 2014/15 but due to other priorities and resource constraints, will start in Q4 2015 once we have discussed with colleagues in ITI.



Service Resilience Capability

Staff and students have been operating more and more on a 24x7x365 basis. Service availability is key to ensure this. While our infrastructure is robust, issues to arise and as we do not have personnel on hand to the same timeframe, an automated facility is required.

To start Q1 2016

Annual upgrades of development tools (JIRA, Bamboo, etc) (15-16)

We have taken on the above products as part of our core workflow for project (and support) delivery in recent times. As such they are essential to our ability to successfully deliver change within the University. Failure to keep the products up to date and in a supportable position exposes us to the risk of serious issues with the software that may affect their ability to run and operate in our environment.

To start Q1 2016

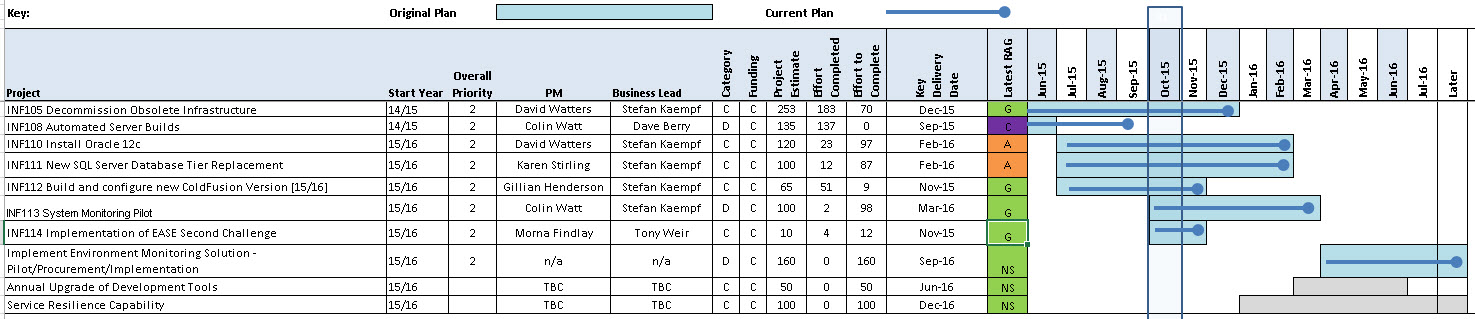

Section Three: Projects in Progress



Project InfoProject Manager's Commentary
INF105 (AP45-053)

Decommission Obsolete Infrastructure

Category: Core Funding



Milestones



16-Nov-2015RedHat decommissioning (15-16) completedBuild
30-Nov-2015Recommendations and procedures signed offDeliver
07-Dec-2015Windows decommissioning (15-16) completedBuild
17-Dec-2015ClosureClose

















RAG Status/ RAG change during last month

GREEN

Report by David Watters for October 2015





Achievements this Period

  • Some work on Password Manager
  • Clarification on CF applications & EOL for annual planning

Issues

  • Need to update later milestones in line with migration projects in other programmes

Next Steps

  • Sign off deployment of Password Manager
  • Update milestones and risks round CF migrations





INF110 (AP56-004)

Install Oracle 12c

Category: Compliance



Milestones

16-Dec-2015Build sign-offBuild
27-Jan-2016Acceptance sign-offAccept
04-Feb-2016Deployment to LIVEDeliver
11-Feb-2016Deployment sign-offDeliver
25-Feb-2016Project closureClose



RAG Status/ RAG change during last month

AMBER

Report by David Watters for October 2015



Achievements this Period

  • New servers delivered by ITI Unix

Issues

  • Lead resource leaving UoE - work to be re-assigned

Next Steps

  • Replan next stages and milestones for remainder of project
  • System analysis to commence



Milestones

Milestones to be replanned (09/11)





INF111 (AP56-006)

New SQL Server Database Tier Replacement

Category: Compliance



Milestones (to be confirmed)

13-Nov-2015Analysis TBC
13-Nov-2015Consultancy & Design TBC
04-Dec-2015Development Environment complete
15-Jan-2016Test Environment Complete
05-Feb-2016Production Environment Complete
18-Mar-2016Acceptance Complete
29-Mar-2016Delivery
12-Apr-2016Deployment Review
26-Apr-2016Closure













RAG Status/ RAG change during last month

AMBER

Report by Karen Stirling for October 2015



Achievement in Last Period

  • Project Brief approval given by WIS on 9th October
  • Microsoft Professional Services have provided a proposal document this has been issued to Project Sponsor / Programme manager for review and request for funding to support project

 Issues

  • Additional scoping call held with Microsoft on 30th Sept – expected proposal document within 2 days however not received until 16th October
  • Discussion with Project Sponsor / Programme Manager for MS funding delayed due to PM on unexpected leave from 5th October until 21st October
  • Head of Development Services has suggested that we use an independent consultant due to the cost of MS proposal, this has been raised up to Director of IS Apps. In the meantime, PM to research local area IT consultants to contact, this will inevitably impact timescales for analysis and design

Next Steps

  • Confirm funding in place for consultancy work
  • Start design and build activities



INF112 (AP56-007)

Build and Configure new ColdFusion Version [15/16]

Category: Compliance



Milestones

10-Nov-2015Delivery
19-Nov-2015Deployment Sign Off
27-Nov-2015Closure















RAG Status / RAG change during last month

GREEN





Report by Gillian Henderson for October 2015



Achievements in Last Period

  • Migrated iSkills Test environment to CF11
  • All testing of iSkills completed sucessfully
  • Acceptance Sign off complete
  • DR Test carried out
  • Handover to Technology Management
  • Updates to Operational doc  including DR procedure and creating new Instance in CF11
  • Prep for live environment including requesting VM's complete.

Issues

  • There was potential for the go-live date of the 17th Nov to be conflicted for as the TTU010 was at risk of being delayed. This was pre-empted by bringing forward the go-live of iSkills on CF11 by one week to 10th Nov.

Next Steps

  • Build CF11 Live Environment
  • Migrate iSkills Live environment to CF11
  • Test iSkills live following upgrade to CF11
  • Deployment Sign off

INF113 (AP56-)

System Monitoring Pilot

Category: Discretionary



Milestones (to be confirmed)



14-Nov-2015End of Planning
11-Mar-2016Delivery
27-Mar-2016Close



RAG Status / RAG change during last month

GREEN

Report by Colin Watt for October 2015

Achievements in Last Period

  • Project Website set up.
  • Initial meeting with stakeholders in ITI to review recommendations from INF107 and agree overall project scope.
  • PM has met with Project Sponsor to follow up on expectations for Project, potential candidate services for pilot.
  • Milestones to be planned assuming pilots with 2-3 services, sequentially, with review after each and final recommendations



Issues

  • No major issues.



Next Steps

  • Complete Project Brief and estimates, agree with stakeholders including directors of IS ITI and Apps.



Section Four: Closed or Withdrawn Projects



Project InfoProject Managers Commentary

INF108 (AP45-034)

Automated Server Builds

Closure approved 11 September 2015.
