Report for September 2012

Report Date
September 2012

Report compiled by Andy Stewart (IS Programme Manager) for David Smyth (Programme Owner)



Section One: Programme Commentary, RAG and Resources Update

Section Two: Projects Not Started

Section Three: Projects In Progress

Section Four: Closed or Withdrawn Projects

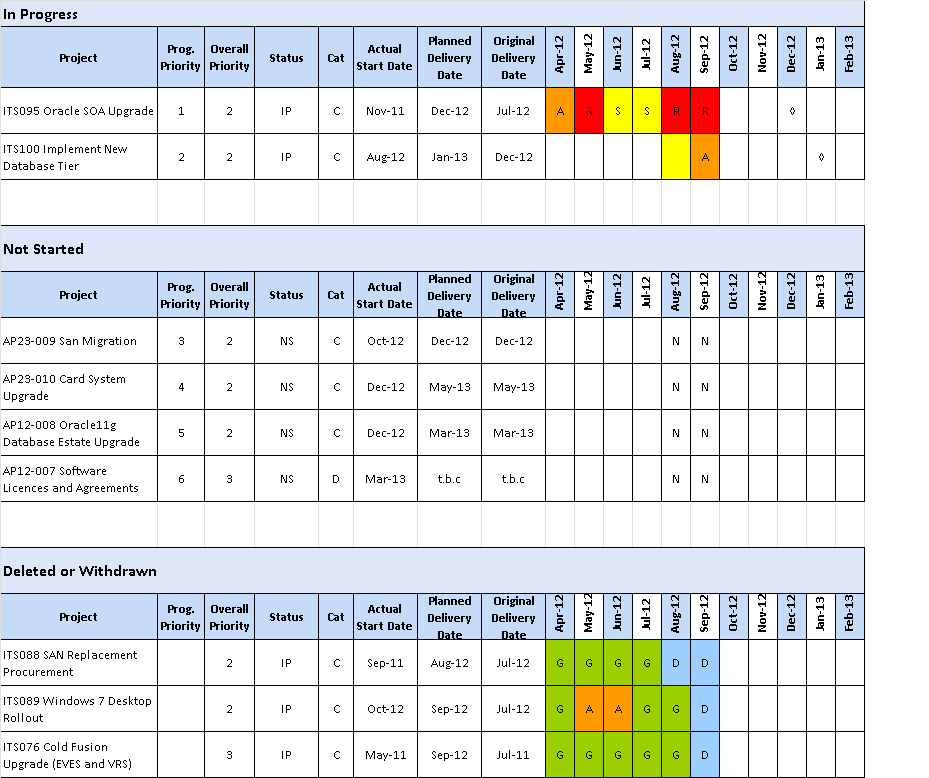

Section One: Programme Commentary, RAG and Resources Update



Work has been on-going with regards the projects carried over from 11/12, in that

  1. ITS089 - Windows 7 managed Desktop has been closed
  2. ITS076 - ColdFusion 9 Upgrade for EVES has been closed

There is however a concern regarding ITS095 - SOA Upgrade as this project remains suspended due to lack of Development resource. Whilst development resource may be available from mid-October, this has still to be confirmed. Any delays in this project will have a serious impact on subsequent in-year projects looking to either undertake a SOA Upgrade or utilise SOA

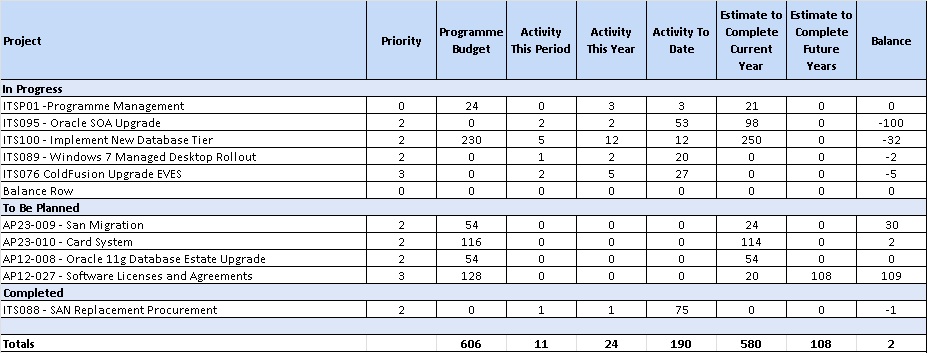

Regarding the overall progarmme budget

  1. To adress the deficit in the programme budget, due to the unplanned carry -over from 11/12, the decison has been taken to defer much of the project relating to Software Licensing and Agreements Management into 13/14.  The project sponsor has highlighted his disappointment regarding this decision and indicated that this is not an ideal situation and is impacting not only Software Services but also Desktop Services and the services we are trying to provide for the DEI, namely an authorisation database to allow staff or students to download software
  2. The project budget for the SAN Migration project has been reduced from 54 days to 24 days.  This is possible due to the functionality of the new SAN Infrastructure to migrate data through mirroring.    The project balance will be re-directed to the project ITS100 - Implement new database tier, whose estimate increased from 230 days to 262 after the planning phase

Minutes of the Programme Meeting





 Section Two: Projects Not Started







Project InfoProgramme Manager's Commentary

AP23-009

SAN Migration

Compliance

Planning October  2012

Delivery December  2012



RAG Status

 GREEN

Plan

Resulting from a meeting held with IS Apps and ITI Unix, it has become apparent that  one of the benefits of the recent SAN Procurement project is that the existing data stored on the 9985 disks will be able to be migrated onto the new SAN infrasatructure through mirroring whilst the application continues to function. As a result it is anticipated that this will be a shorter project than initially anticipated at the annual planning stage.

Once the initial process has been tested, the main objective of the project will be to plan and coordinate the data migration with the various business areas and the technical teams.

The progarmme manager will further discuss planning at the programme meeting with the programme and portfolio managers



Dependencies

Whilst there are no specific dependancies on this project, the technical view is that it would be preferable to migrate the data to the new SAN prior to the new database tier becoming operational

AP23-010

Card System Migration

Compliance

Planning December 2012

Delivery May 2013



RAG Status

GREEN

Plan

Commence the project late November to enable the planning phase to be completed before the Christmas holidays



Dependencies

Coordination will be required with Card System changes associated with Distance Learning

It should also be noted that all functional requirements and testing is currently coordinated through one individual in Card Services

AP12-008

Oracle 11g Database Estate Upgrade

Compliance

Planning January 2013

Delivery March 2013



RAG Status

GREEN

Plan

This remaining databases associated with this project relate to the follwoing two databases; IDM - The project manger will consult with programme owner of the Communications programme to ascertain if the database upgrade could be incorporated into the project 'Migrating IDM to Oracle SOA Suite 11g'.  If acceptable, arrangements will be made to transfer 50% of the budget, namely 27 days to Communications programme.

ERI



 Dependencies

Requirement to contact the supplier InfoEd to determine the if the current application supports Oracle 11g

  AP12-027

Software Licences and Agreements Management

Compliance

Planning March 2013

Delivery October 2013



RAG Status

GREEN

Plan

Due to current budget limitations it will not be possible to complete this project this year and as a result will be started end of the 3rd quarter and will require to be carried forward into 13/14. The project sponsor has highlighted his disappointment regarding this decision and indicated that this is not an ideal situation and is impacting not only Software Services but also Desktop Services and the services we are trying to provide for the DEI, namely an authorisation database to allow staff or students to download software.   In addition, the project sponsor has voiced his concern that there is an ever increasing number of knock-backs and come April 2013 is not convinced that the project will commence



Dependencies

Sufficient budget to complete required project development



Section Three: Projects in Progress







Project InfoProject Managers Commentary

ITS095  (AP12-031)

Upgrade of Oracle SOA Suite



Category:Discretionary

Milestones

N/A

RAG Status

RED

Report by Andrew Stewart (on behalf of Stevie Conlon) for September 2012

Achievements in Last Period

The project remains suspended

The programme owner has raised concerns regarding the on-going delay to this project as

  1. SOA 10g is only supported till December 13
  2. Oracle 10g is only supported to July 12
  3. This will impact on the project(s) with any dependancies regarding SOA 11g, e.g. AP23-001 Migrating IDM to Oracle SOA suite 11g and the associated IDM database upgrade to Oracle 11g

 Issues

It has not been possible to secure any resource from Development to commence the system design

Next Steps

Programme Manager to organise a meeting with the Programme Owner, Project Sponsor and Project Manager to determine when the project can commence





ITS100  (AP23-008)

Implement New Database Tier

Category: Compliance

Milestones



Target dateTitle
03-Oct-2012Business & System Analysis sign-off
03-Dec-2012Build sign-off
18-Dec-2012Acceptance Sign Off
30-Jan-2013Deployment Sign Off
07-Feb-2013Project closure approved

RAG Status

AMBER

Report by David Watters for September 2012

Achievements in Last Period

  1. Estimation meeting held and draft estimate produced
  2. Training for Dev Tech and Tech Management staff arranged
  3. Project wiki for documentation established
  4. Estimations completed and brief finalised
  5. Brief submitted to WIS
  6. Updated brief passed by WIS
  7. Plan input into ASTA and initial booking requests submitted

Issues

 Programme owner has expressed concerns around timings and bookings and as a result, the proejct has been allocated an Amber status until this has been resolved

Next Steps

  1. Get agreement on possible use of virtualisation
  2. Start work on technical documentation
  3. Arrange procurement of hardware



Section Four: Closed or Withdrawn Projects







Project InfoProject Managers Commentary

Project Code:  AP12-907

Project Title:  New SAN Infrastructure Procurement



Discretionary

Report by Andrew Stewart

This project was closed on 24-08-12

Please see the Completion Report for further information









Project Code:  AP12-904

Project Title: Windows 7 Managed Desktop Rollout



Compliance

Report by Andrew Stewart

This report was closed on 14-09-12

Please see the Completion Report for further information

Project Code

ColdFusion Upgrade - EVES



Category:Compliance

Report by David Watters

This project was closed on 28-09-12

Please see the Completion Report for further information
