Report for May 2017

Report Date
May 2017

Morna Findlay (IS Apps Programme Manager) for Zoe Lewandowski (Programme Owner)



Section One: Programme Commentary, RAG and Resources Update



Commentary



The programme manager considers that overall the programme is GREEN, as all projects which were not withdrawn will be delivered this year and within the programme budget.



It is expected that the HR Balance row will reduce further from the current 42 days as the  30 days set aside to deliver reports not delivered under HRS077 are expected to be produced through another channel.



This further reduction will result in an increase to the average monthly utilisation rate.



Projects in Progress: summary



HRS091 - RED  (Change approved) as new budget and milestones were approved.

HRS092 - GREEN



Forward Look for May 2017

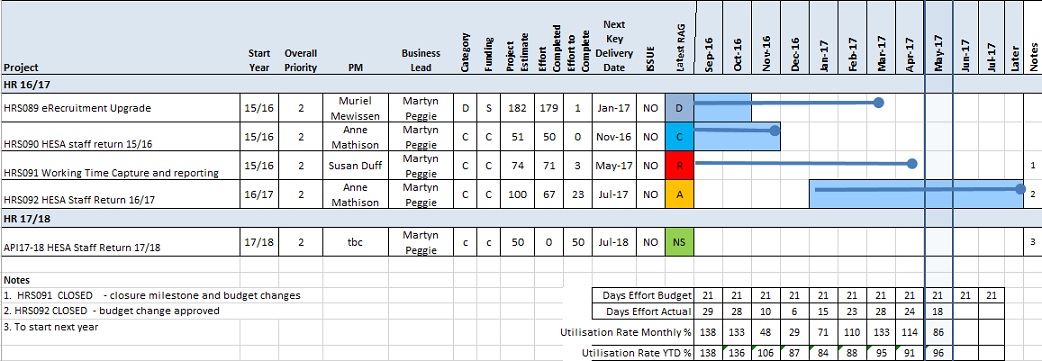

Resources to 02/06/2017



With the postponement  until future years of the upgrade of  Erecruitment  to Oracle 12c, there are  a significant number of days remaining in the balance row which are currently unallocated. These days are expected to be returned to the portfolio, with the agreement of he programme owner.  New in-year projects should fall under the compliance category.







 Section Two: Projects Not Started



There are no approved projects waiting to start.





Section Three: Projects in Progress



Project Info Project Managers Commentary

HRS089 (AP56-907)

eRecruitment Upgrade



Category: Funded

Milestones

Closed



RAG Status

BLUE



Report by Muriel Mewissen for May 2017

Achievements in the last period

Issues

  • None

Next Steps

  • None



HRS091 (AP56-049)

Working Time Capture and Reporting ( was Enhancing Employment Technical Implementation)

Category: Core Funded

Compliance

Milestones

02-Jun-2017      eTime Report Deployment Sign Off
23-Jun-2017      Closure



RAG Status

RED (No issues)

Report by Morna Findlay for Susan Duff, for May 2017

Achievements in Last Period

  • Remaining JIRA issues closed
  • New milestones and budget approved

Issues

  • Sign off of e-time report and deployment sign off delayed due to project manager illness but work is complete and has been signed off by business lead.

Next Steps

  • Approve  e-Time and Deployment Sign Off
  • Project closure

HRS092 (AP67-034) HESA Staff Return 16/17

Category : Core-funded

Compliance

Milestones

28-Jul-2017 First Deployment
29-Sep-2017 Submit HESA Return
13-Oct-2017 Commit
10-Nov-2017 Final Submission
04-Dec-2017 Closure

 RAG Status

GREEN

Report by Anne Mathison for May 2017

Achievements:

  • Internal project resourcing agreed to take over from contractor.
  • Revised project budget
  • Revised budget approved
  • Majority of RESAST with code have been resolved
  • A fix has already been successfully completed this month relating to CONFTE (HRS092-10) and the bug with a smaller number of RESAST (HRS092-12) is in progress

Issues

  • None

Next Steps

  • RESAST (HRS092-12) to be resolved, although 143 records are affected and is required it is not holding up general  live testing
  • Support HESA testing
  • RESAST will require data file loaded at end July

Project has a RAG status of GREEN



Section Four: Closed or Withdrawn Projects

Project Info Project Managers Commentary

AP67-035 Upgrade eRecruitment Database to Oracle 12c

CategoryL Compliance

This project has been withdrawn from the  current year as the end. of life for Oracle 11g has been extended till 2020 . There may be no requirement for the upgrade if erecruitment is replaced. This project will  therefore be planned for  18/19-19/20.

HRS090 (AP56-025)

HESA Staff Return 15/16

Category:Compliance

Report by Anne Mathisson

Project Closure Milestone achieved on 25-Nov-16, Project Completion Report available on the website

HRS086 eRecruitment Proof of Concept

Category: Discretionary, Funded

Report by Susan McKeown

Project Closure Milestone achieved on 25-Aug-15 Project's Completion Report is available on the website.

HRS085 HESA Staff Return 14/15

Category: Compliance

Report by Anne Mathison

Project Closure Milestone achieved on 20-Nov-15 Project's Completion Report is available on the website.

HRS087 HR Reward Calculator

Category: Funded

Report by Susan McKeown

Project Closure Milestone achieved on 18-Dec-15 Project's Completion Report is available on the website.

HRS088 HR Transformation: Governance and Planning

Category: Compliance

Report by Susan McKeown

Project Closure Milestone achieved on 18-Dec-15 Project's Completion Report is available on the website

HRS084 Enhancing Employment Analysis

Category: Discretionary

Report by Franck Bergeret

Project Closure Milestone achieved on 18-Feb-16 Project's Completion Report is available on the website

HRS090 HESA Staff Return 15/16

Category : Compliance

Report  by Anne Mathison

Project Closure Milestone achieved on 24-Nov-16 Project's Completion Report  is available on the website

HRS091 Erecruitment Upgrade

Report by Muriel Mewisson

Project Closure Milestone achieved on 2-Jun-2017 Project's Completion Report  is available on the website
