February 2018

Report Date
February 2018

Section One: Programme Commentary, Forward Look and Resource Position

Section Two: Projects Not Started

Section Three: Projects In Progress

Section Four: Closed or Withdrawn Projects

Section Five: Programme Risk Register

Section Six: Programme meeting Minutes

Section One: Programme Commentary, RAG and Resources Update

During February,

From a programme perspective;

The only current activity is centred around the project ACS039 - Kx Infrastructure Consolidation.

The programme budget remains unchanged at 91 days.  The 10 days remaining in the Sponsor Funded balance row remain unaltered in case required for the agreed contingency (12 days) for ACS039.

Forward Look

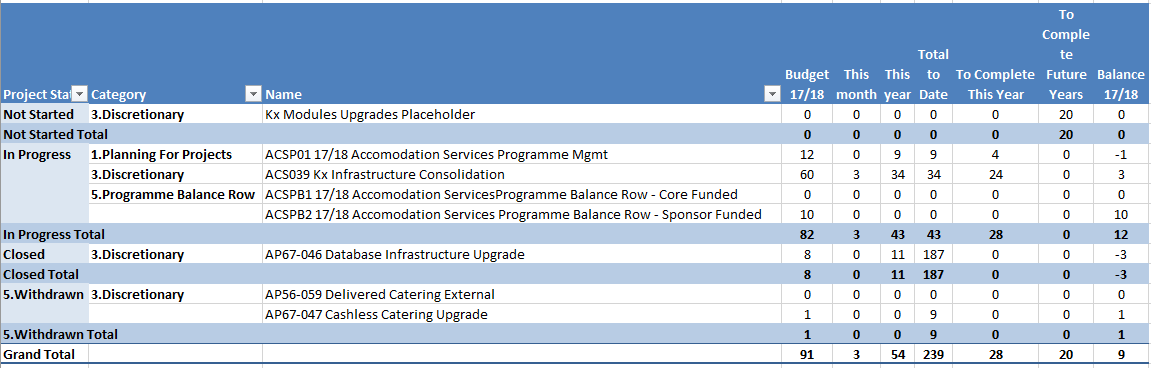

Resource Position

Section Two: Projects Not Started

The scheduled projects for 2016-17 are:

Project Info Programme Managers Commentary

ACS040

Kx Modules Upgrades Placeholder

Funded

Planning: September  2018

Delivery t.b.c.

Plan

This project has been declared as part of the annual planning process and has subsequently been deferred to 2018-19

Dependencies

- dependant on Accommodation, Catering and Events to manage User Acceptance Testing

- will require input from IS Applications Production Management

Section Three: Projects in Progress

Project Info Project Managers Commentary

ACS039

Kx Infrastructure Consolidation

Category: Discretionary

Sponsor Funded

Milestones

Target Date Title
16-Mar-2018 Operations Level Agreement
30-Mar-2018 Kx 2017 Functional Testing Completed
13-Apr-2018 Database Infrastructure Performance Review on Test Environment
27-Apr-2018 Closure

Nb. The current project milestones are based on the understanding that the project will close after successfully completing the performance tests against Kx version 2017 on the new Test infrastructure

RAG Status

Amber

Report by Andy Stewart  for February  2018

Achievements in the last period

  • New Test environment
    • The connectivity issues with the new test database and the Kx client application have been resolved
  • Kx version 2017
    • Functionality testing has commenced on the current Test infrastructure.  ACE are liaising with the supplier regarding any issues encountered
  • Test Scripts
    • The development of the Test scripts have been completed by the supplier and are currently under peer review, with delivery expected w/c 5th March
  • Project plan
    • The project plan has been adjusted to incorporate the revised testing schedule and has been circulated for approval. The current project milestones are based on the understanding that the project will close after successfully completing the performance tests against Kx version 2017 on the new Test infrastructure.   The subsequent go-live for Kx version 2017 will be managed via KSR as normal
  • OLA
    • First draft has been produced and is currently being reviewed within IS Applications Management

Issues

  • Currently no issues to report

Next steps

  • Project Plan
    • Project plan, incorporating Kx 2017 to be finalised.  Requirement to clarify whether the Kx 2017 go-live activity is managed within this project or part of KSR
  • Kx 2017 (Current Test Infrastructure)
    • Continue the functional testing
    • Commence running of Test scripts
  • Test Environment
    • Complete configuration of new Test infrastructure, incorporating the activities specified by KSL
    • Migrate test environment from current Test infrastructure
    • Commence functional and load testing
  • OLA
    • Complete document and circulate for further review with ACE

RAG Commentary

Amber - Project re-planned to accommodate change of scope to incorporate upgrade to Kx version 2017 and there is a risk that this could impact on the current planned delivery date

Section Four: Closed or Withdrawn Projects

Project Info Project Managers Commentary
ACS037

Cashless Catering Upgrade

Project withdrawn on 18th August

Project Completion Report

ACS036

Kx Database Infrastructure Upgrade

Project closed on 22/09/2017

Project Completion Report

AP56-059

Delivered Catering External

Project withdrawn on 12/01/2018

Section Five: Programme Risks

Date Updated Risk Ref. Programme Risks RAG Status Risk Owner
18/01/18 6

Programme Management budget for 2017-18 being exceeded For the December  report, the usage (6 days) is currently over with the predicted spend (5 days)

Green Andrew Stewart

Section Six : Programme Meeting Minutes

 This section details the minutes from the programme meetings

Date Comments
14/12/16 Minutes from November Programme Meeting
16/11/16 Minutes from October Programme Meeting
16/11/16 Minutes from In-Year Project Review Meeting
12/10/16 Minutes from September Programme Meeting
14/09/16 Minutes from August Programme Meeting
15/08/16 Minutes from 2016-17 Projects Review and Planning Meeting
18/05/16 Minutes from Programme Meeting
02/12/15 Minutes from Programme Review Meeting
11/11/15 Minutes from Programme Meeting
16/09/15 Minutes from Programme Meeting
12/07/17 Minutes from Programme Meeting
13/09/17 Minutes from Programme Meeting
AttachmentSize
Image icon 201802_resources.png35.05 KB
Image icon 201802a-rag.png36.43 KB

Documentation

Not available.
