Report for March 2013

Report Date
March 2013



Report compiled by Maurice Franceschi (IS Apps Programme Manager) for Mark Wetton and Anne-Marie Scott (Programme Owners)



Section One: Programme Commentary, RAG and Resources Update

Section Two: Projects Not Started

Section Three: Projects In Progress

Section Four: Closed or Withdrawn Projects

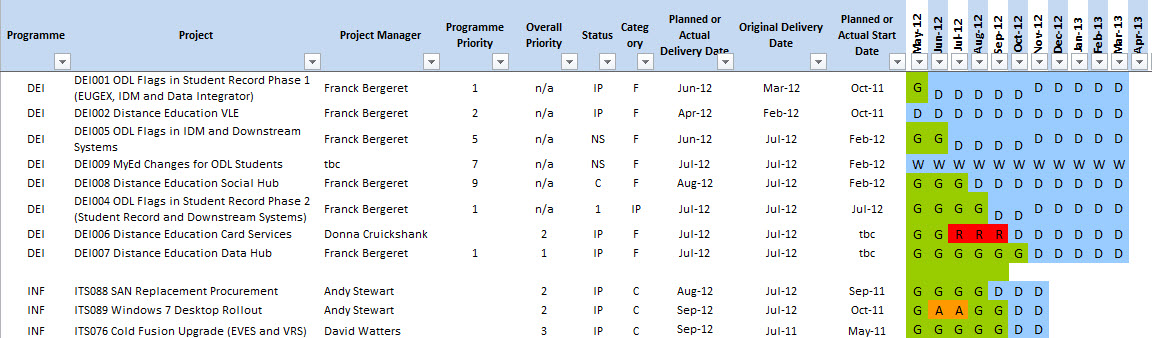

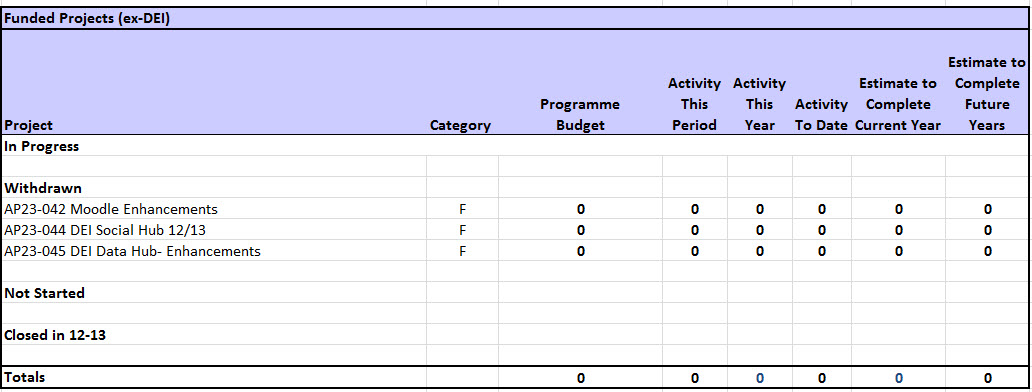

Section One: Programme Commentary, RAG and Resources Update

The programme budget has been reviewed by senior management and is now set as 448 days, with 284 days for Core funded projects and Programme Management, and 164 days for the projects funded by College Ring-Fence. All planned and in-year projects are in progress. The summaries below reflect the distinction in the funding of projects.

Actions from programme meeting.



















 Section Two: Projects Not Started

No further projects



Section Three: Projects in Progress

Project InfoProject Managers Commentary

TEL001 (AP23-018)

Pebblepad Upgrade Compliance

Core

Milestones



Target dateTitle
31-May-2013User Acceptance (ASOR)
14-Jun-2013Delivery
21-Jun-2013Deployment Sign-Off
28-Jun-2013Closure



RAG Status

GREEN

Report by Laura Bell for March 2013

Achievements in Last Period

  • Sign off PPBR
  • Deprovisioning approach agreed; no further development work
  • Budget revised to revised scope - now 34 days



Issues

  • The current status is Green.
  • Potential risk that, following impact assessment with key users, additional support for transition may be required within USD



Next Steps

  • Complete integration testing
  • Complete impact assessment with Specialist Users





TEL002 (AP23-037)

Speedwell Database Hosting

MVM College Ring-Fenced



Milestones

01-Mar-2013ASOR sign off acceptance
14-Mar-2013Deploy Live
19-Mar-2013Deployment sign off DSOR
01-Apr-2013Closure


RAG Status

AMBER



Report by Maurice Franceschi for March 2013



Achievements in Last Period

  • Delivery started

Issues

  • The installation of Speedwell has failed on one machine, so deployment not complete. Set status as Amber as we need to restate the compeltion date and closure.

Next Steps

  • Complete Deployment to Live

TEL003 (AP23-35)

Extension of SMART to HSS with Enhancements

HSS College Ring-Fenced

Milestones





11-Mar-2013Phase 1: SMARTMI Update ASOR
13-Mar-2013Phase1: SMARTMI Update Deploy
08-Mar-2013Phase 2 Null Values PPBR
08-Apr-2013Phase 2 Pass/Fail: ASOR
11-Apr-2013Phase 2 Null Values ASOR
15-Apr-2013

 Phase 2 Pass/Fail: Deploy

15-Apr-2013 Phase 2 Null Values Deploy to Live

RAG Status

AMBER

Report by Maurice Franceschi and David Watters forMarch 2013

Achievements in Last Period

1.Phase 1 reporting:

  • Build completed.

2. Phase 2 enhancements:

  • Pass/Fail: UAT passed. Fixes put in place & awaiting deployment. Further analysis on PGT courses.
  • Null Values: build completed and peer testing started. To be completed

Issues

  • Phase1: There is a delay on the UAT, due to issues around SMARTMI refresh and Boxi Reports. Need to confirm that testers are still available . Accordingly setting status to Amber as there is a risk we may miss delivery before the Freeze Period.
  • Phase 2: Delay to completion of Null Values peer testing because of misunderstanding over student types. Led to further analysis of coursework/class only listings

Next Steps

  • Phase 1 reporting:
    • UAT for Boxi Report and SMARTMI
  • Phase 2 enhancements:
    • Pass/Fail:Build and review (for PGT courses) , UAT and deployment
    • Null values: Testing and deployment.





IS Apps Excluding SM

IS Apps Including SM

Approved Budget

129

141

Activity this month

26.5

28

Activity this year

115

126

Activity to date

115

126

Effort to Complete 12/13

14

15



TEL004 (AP23-043)

Moodle Upgrade

Compliance

Core



Milestones

10-Apr-2013Build Review PPBR
31-May-2013Deploy to Test
21-Jun-2013Acceptance ASOR
08-Jul-2013Deploy to Live
15-Jul-2013Deployment sign off DSOR
23-Jul-2013Close



RAG Status

GREEN

Report by Maurice Franceschi for March 2013

Due to issues, there has been a slight delay in the testing of Plugins. However, project remains on course.

Achievements in Last Period

  • TAD signed off

Issues

  • N/A

Next Steps

  • Review, deploy and test plugins
  • Complete fixing new Theme bugs





TEL005 (AP23-904)

ODL Image Upload for Card Services

Discretionary

Core



Milestones



Target dateTitle
12-Apr-2013PPIR Phase 2 (Peer Project Integration Review)
22-Apr-2013ASOR Phase 2 (Acceptance Sign Off Review)
26-Apr-2013Deploy to Live
10-May-2013DSOR Phase 2 Sign off (Deployment Sign off review)
24-May-2013Project Closure



RAG Status

GREEN

Report by Laura Bell for March 2013

Achievements in Last Period

  • PPBR signed off

  • Project replanned to enable improvements to MyEd environments to complete

  • Budget re-estimated and revised budget approved of 24 days

  • MyEd publication and communication strategy agreed

Issues

  • The current status is Green

  • Potential Risk that the MyEd Test environment refresh (due to complete 5th April) could impact project if delayed

Next Steps

  • Sign off PPIR

  • Sign off ASOR

  • Deploy to Live

TEL006 (AP23-907)

Learn Enhancements

Discretionary

Core

Milestones



12-Apr-2013Design Signed-Off
20-May-2013Build Signed Off
11-Jun-2013User Documentation Complete
24-Jun-2013Acceptance Signed Off
27-Jun-2013Deployed in LIVE
17-Jul-2013Deployment Signed Off
23-Jul-2013Project Closed

RAG Status

GREEN



Report by Alex Wood for March 2013



Activities completed in this period

  • Planning milestone signed off
  • BRD written
  • Systems design commenced
  • Comms plan produced



Issues

 No issues



Activities to complete in next period

  • Complete and sign-off system design
  • Commence build



Section Four: Projects Closed / Withdrawn



Project InfoProject Managers Commentary

LAT010 (AP12-022)

VLE upgrade to Learn 9.1

Compliance

Milestones 28-09-2012 Closure



Project completed.

Closure Report

LAT011 (AP12-030)

Virtual Classroom Implementation

Very Important

Milestones

Target dateTitle
07-Dec-2012Closure

Report by Tim Gray for November 2012

Achievements in Last Period

Phase 3:

  • Delivery milestone achieved
  • Deployment Sign Off milestone achieved

Issues

  •

Next Steps

  • Closure

AP12-044

Social Hub Enhancements Funded

Withdrawn

AP12-042

Moodle Enhancements Funded

Withdrawn

AP23-045 DEI Data Hub- Enhancements

Funded (IS)

Withdrawn



Actions from October Programme Meeting (12th November)



Main action was the prioritisation of the Annual Planning proposals - see above.
Review how a TEL/TELS programme could be set up for SM/USD projectsMaurice


Actions from September Programme Meeting (5th October)

Fix programme report so that the images fit on a screenMauriceDone
Add previous monthly programme actions onto current reportMauriceDone
Ask for Registry to take on SMART projectMaurice

Maurice talked to Karen on Monday 8th and has asked for this transfer. Karen to get back.



When is the current review of programme and project structure expected to completeMaurice to find outOngoing
Pebblepad Funding - clarify situationBryan to talk to SimonDone
LAT010 is not showing as Closed on prject websiteMaurice to actionDone

We will focus on New MyED, given the current on schedule status of the MyED Upgrade Project. The risk of not having a working Old MyED channel to be accepted, with the three daysd Richard has w/c 22nd to be used as fallback if the upgrade is postpoened or backed out.



Programme Owners to confirm the approach and who owns the risk,



Programe owners to decide if project board needs to be informed.


Email to confirm the New My ED approach to Project Team.TimDone


Prgoramme owners of DEI and TEL agreed that the DEI projects should be moved into TEL programme, as DEI will not be funding DEI projects in 2012/13.



Maurice to request expansion of TEL programme with transferred projects, and removal of DEI programme.

Programme Owners/Simon to confirm the Funding for DEI projects.

DEI Pcode effort to be transferred over to TEL programme management.

Done

For PebblePad v 3, we need user requirements and the dates when an upgrade can be scheduled (May-July?) confirmed.Mark to talk to Robert C.
