January Report
- Report Date
- January 2013
Report compiled by Maurice Franceschi (IS Apps Programme Co-ordinator) for Mark Wetton and Anne-Marie Scott (Programme Owners)
Section One: Programme Commentary, RAG and Resources Update
Section Two: Projects Not Started
Section Three: Projects In Progress
Section Four: Closed or Withdrawn Projects
Section One: Programme Commentary, RAG and Resources Update
After a busy mid-year period, we find ourselves with the 'DEI' projects withdrawn, and two new in-year project started for ODL Image Upload and for Learn Enhancements.

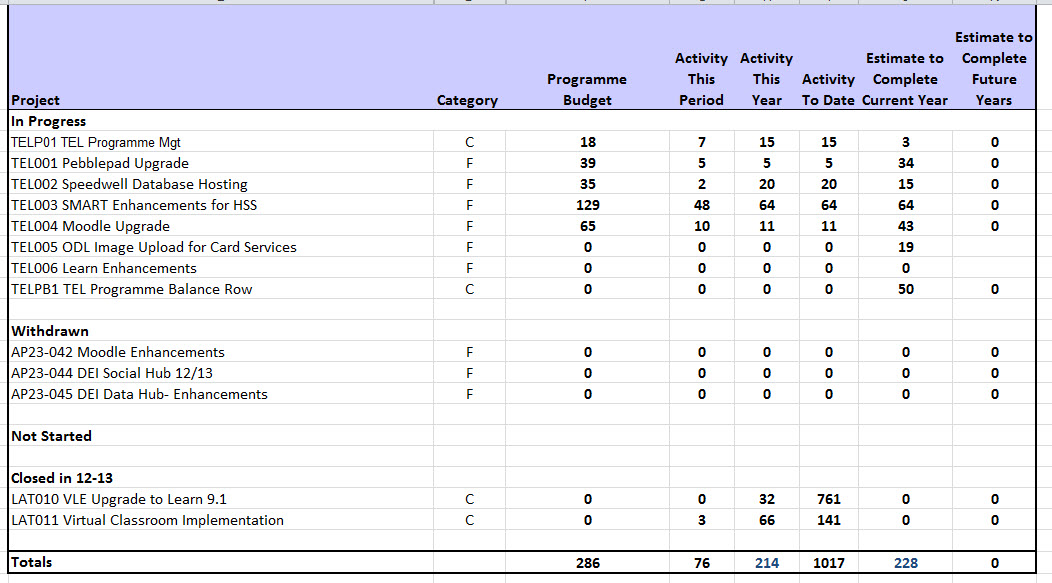

The programme budget is 286 days, with total effort planned as 442 days, so is 156 days over .
The funding for the two new in-year projects for 20 and 50 days respectively is not yet confirmed, although the projects have been allowed to start on the understanding this will happen. We also have a further overspend of 85 days for the LAT010 and LAT011 projects, which is to be reviewed by IS Director mid-year as already agreed.
13/14 Annual Planning is
1. Moodle Upgrade
2. EVS - Voting System Enhancements (Clickers)
potentially
3. Learn Mobile
4. Annotation Hosted Service
In addition to the 'Applications' programme, TEL/TELS may set up a programme of projects run by and using Service Management andf USD resoruces. Projects such as Collaborate Upgrade, Analytics would then be placed in a wider, visible context. How best to set this up will be looked at by programme manager and stakeholders soon.
Actions from programme meeting.


Section Two: Projects Not Started
No further projects
Section Three: Projects in Progress
| Project Info | Project Managers Commentary | ||||||||||||||||||||||||||||
TEL001 (AP23-018) Pebblepad Upgrade Compliance Funded (IS) Milestones

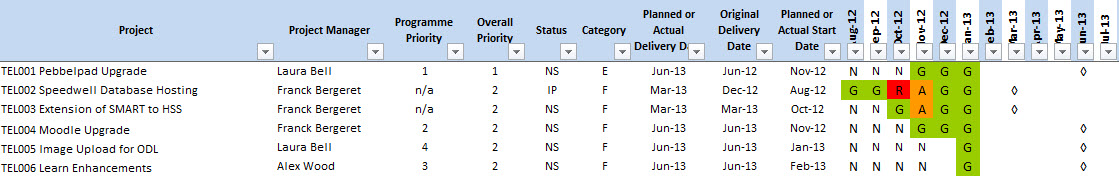

RAG Status GREEN | Report by Maurice Franceschi for November 2012 Achievements in Last Period
| ||||||||||||||||||||||||||||
TEL002 (AP23-037) MVM College Ring-Fenced
Milestones
RAG Status GREEN
| Report by Franck Bergeret for January 2013
Achievements in Last Period
| ||||||||||||||||||||||||||||
TEL003 (AP23-35) Extension of SMART to HSS with Enhancements HSS College Ring-Fenced Milestones
RAG Status GREEN | Report by Franck Bergeret for January 2013 Achievements in Last Period
2. Phase 2 enhancements:
| ||||||||||||||||||||||||||||
TEL004 (AP23-043) IS Funded
Milestones
RAG Status GREEN | Report by Franck Bergeret for January 2013 Achievements in Last Period
| ||||||||||||||||||||||||||||
TEL005 (AP23-904) ODL Image Upload for Card Services Funding: TBC
Milestones
RAG Status RED | Report by Laura Bell for January 2013 Achievements in Last Period
Issues
Next Steps
| ||||||||||||||||||||||||||||
TEL006 (AP23-907) IS Funded Milestones
RAG Status
| Report by Maurice Franeschi for January 2013 Project submitted to WIS for approval to start, 8/2/12
|
Section Four: Projects Closed / Withdrawn
| Project Info | Project Managers Commentary | ||||
LAT010 (AP12-022) Compliance Milestones 28-09-2012 Closure
| Project completed. | ||||
| LAT011 (AP12-030) Virtual Classroom Implementation Very Important Milestones
| Report by Tim Gray for November 2012 Achievements in Last Period Phase 3:
Issues Next Steps
| ||||
AP12-044 Social Hub Enhancements Funded | Withdrawn | ||||
AP12-042 Moodle Enhancements Funded | Withdrawn | ||||
AP23-045 DEI Data Hub- Enhancements Funded (IS) | Withdrawn |
Actions from October Programme Meeting (12th November)
| Main action was the prioritisation of the Annual Planning proposals - see above. | ||
| Review how a TEL/TELS programme could be set up for SM/USD projects | Maurice | |
Actions from September Programme Meeting (5th October)
| Fix programme report so that the images fit on a screen | Maurice | Done |
| Add previous monthly programme actions onto current report | Maurice | Done |
| Ask for Registry to take on SMART project | Maurice |
Maurice talked to Karen on Monday 8th and has asked for this transfer. Karen to get back.
|
| When is the current review of programme and project structure expected to complete | Maurice to find out | Ongoing |
| Pebblepad Funding - clarify situation | Bryan to talk to Simon | Done |
| LAT010 is not showing as Closed on prject website | Maurice to action | Done |
We will focus on New MyED, given the current on schedule status of the MyED Upgrade Project. The risk of not having a working Old MyED channel to be accepted, with the three daysd Richard has w/c 22nd to be used as fallback if the upgrade is postpoened or backed out.
| Programme Owners to confirm the approach and who owns the risk,
Programe owners to decide if project board needs to be informed. | |
| Email to confirm the New My ED approach to Project Team. | Tim | Done |
Prgoramme owners of DEI and TEL agreed that the DEI projects should be moved into TEL programme, as DEI will not be funding DEI projects in 2012/13.
| Maurice to request expansion of TEL programme with transferred projects, and removal of DEI programme. Programme Owners/Simon to confirm the Funding for DEI projects. DEI Pcode effort to be transferred over to TEL programme management. | Done |
| For PebblePad v 3, we need user requirements and the dates when an upgrade can be scheduled (May-July?) confirmed. | Mark to talk to Robert C. | |
