February 2017

Report Date
February 2017

TEL Programme Report compiled by Colin Watt, (IS Apps Programme Manager) for Programme Owner Anne-Marie Scott



Section One: Programme Commentary, RAG and Resources Update

Section Two: Projects Not Started

Section Three: Projects In Progress

Section Four: Closed or Withdrawn Projects



Section One: Programme Commentary, RAG and Resources Update



Projects in Progress:



TEL031 VLE Student Analytics

TEL033 Learn and Student Record Grade Exchange Feasibility Study

TEL034 Lynda.com Implementation

TEL042 Virtual Classroom - Options Appraisal and Procurement

TEL043 Learn Upgrade

TEL044 Pebblepad Upgrade

TEL045 Annual Moodle Upgrade

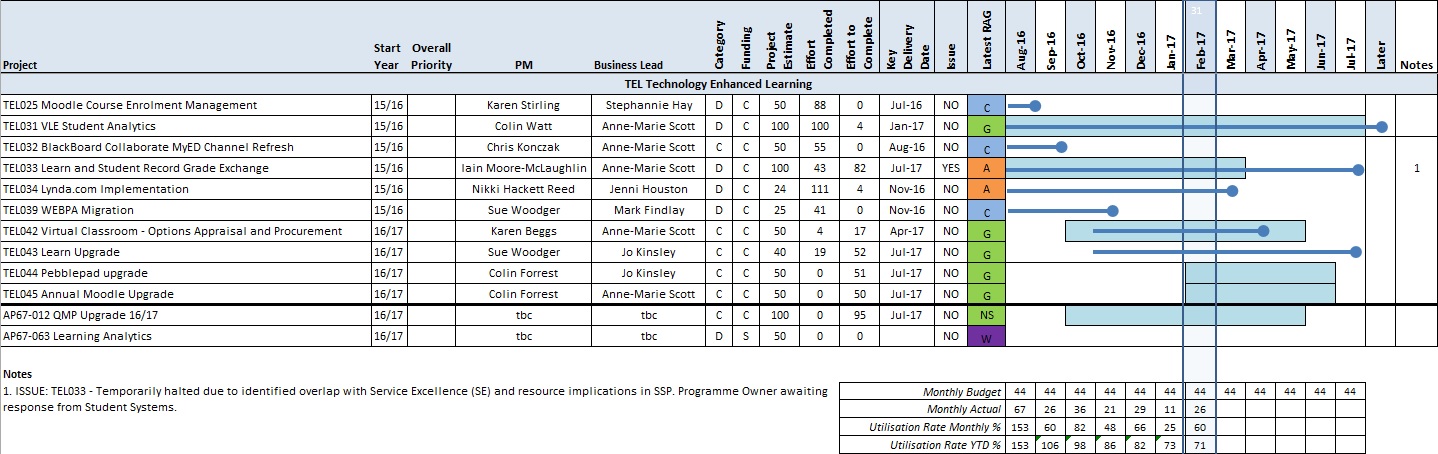

Forward Look and RAG

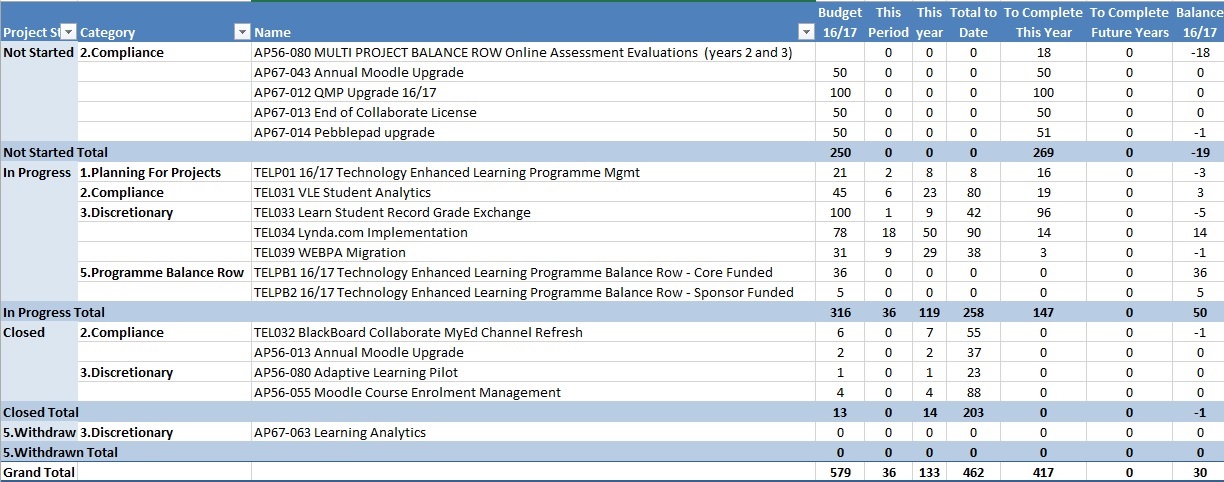

Resource Summary



Section Two: Projects Not Started



Project Info Project Manager's Commentary
AP67-012 QMP Upgrade 16/17 Scheduled start: March 2017
AP67-063 Learning Analytics Funded days have been transferred to TEL031 and this year's project withdrawn





Section Three: Projects in Progress



Project Info Project Manager's Commentary

TEL031

VLE Student Analytics

Discretionary

Milestones



31-Mar-2017

Check point End March

30-Jun-2017

Check point End June

29-Sep-2017

Check point End September

15-Dec-2017

Check point End December

31-Jan-2018

Close

RAG Status: GREEN



Report by Colin Watt for February 2017

Achievements in Last Period

  • Civitas onsite 27 Feb
  • Kanban reviewed at team meeting 24/02. Plan to be revised based on progress and following meetings with Civitas 27/02.
  • Progress on Data Validation; Digital Education looking more solid but issues raised mean we want to look at more programmes (<5) to be sure that the model is scaleable before signing off.
  • Progress made on definitions; Civitas working on this and sharing with Stephannie and Lesley.



Issues

  • Data Validation not yet signed off (see above); Civitas accept the need to test the model against other programmes.
  • Turnaround time is an issue; Civitas have agreed to the proposal made to them that UoE and them dedicate time in a focussed few days period during March and we are working with them to confirm availablity to get the data validation completed.
  • Project Board has had to be moved due to diary conflicts; the work on the paper for KSE is to be presented at the rescheduled PB 27/04.



Next Steps

  • Data Validation complete by end March.
  • Civitas onsite during March (dates tbc).
  • Deep dive into further programmes during March.
  • Recommendations from Dragan and Sian.
  • Paper for next KSC meeting to be completed ahead of Project Board 27/04/17.





TEL033

Learn and Student Record Grade Exchange

Discretionary

Milestones

(tbc dependant on decision)

RAG Status: AMBER





Report by Colin Watt for Iain Moore-McLaughlin for February 2017

Achievements in Last Period

  • No progress; Project Sponsor has advised that there is likely to be no further progress on this initiative until a decision is made on direction; Project Sponsor has contacted Karen Osterburg to agree whether any progress can be made otherwise the expectation is that the unused project days will be returned to the programme; a decision on this is expected ahead of the March TEL Programme meeting.

Issues

  • Project may be subsumed into Service Excellence programme and may cease to exist from an IS perspective (See recent issue statements).
  • Responses from Service Excellence Programme are delayed. Sponsor is discussing the situation with Director of Learning and Teaching to establish best way forward.

Next Steps​

  • Await feedback on the above.

NB updated by Programme Manager for Project Manager

TEL034

Lynda.com Implementation

Discretionary

Milestones

Target date

Title

Complete

01/03/17 (11/01/17)

Delivery

NO

08/03/17 (31/01/17)

Closure

NO

RAG Status: AMBER



Report by Nikki Hackett Reed for February 2017

Achievements in Last Period

1st iteration of UAT completed - fixes implemented

2nd iteration of UAT completed - fixes implmented

Issues

Resource Conflict

https://www.projects.ed.ac.uk/unpublished/project/tel034/risks/29

Business Lead availability to complete UAT and address outstanding JIRA's

https://www.projects.ed.ac.uk/unpublished/project/tel034/issues/42

Next Steps

Review/revise milestones to reflect extended UAT

3rd iteration of UAT completed - ASOR

Deployment Checklist completed

Handover/Deploy

Closure report completed - DSOR

Project closed

TEL042

Virtual Classroom - Options Appraisal and Procurement

Compliance

Milestones

27-Jan-2017 End of Planning
14-Mar-2017 Complete market review
31-Mar-2017 Decision based on Market Review
14-Apr-2017 Project Closure



RAG Status: GREEN





Report by Karen Beggs for February 2017

Achievements in Last Period

  • Project brief completed and approved
  • Research into Virtual classroom tools undertaken, including analysis of features
  • End of Planning Stage signed off
  • Additional stakeholders identified and communication issued (email / meetings as appropriate)
  • Survey created and published to gather more detailed user feedback
  • Survey open until 8th March
  • Use cases being developed

Issues

  • No major issues

Next Steps

  • Survey analysis & options appraisal paper to be written
  • Options Appraisal paper to be distributed 17th March 2017
  • Review meeting and decision on 27th March



TEL043

Learn Upgrade

Compliance

Milestones

10-Apr-2017

 Build

05-May-2017

 Integration

23-Jun-2017

 Acceptance

04-Jul-2017

 Deploy

20-Jul-2017

 Deployment review

26-Jul-2017

 Close



RAG Status: GREEN



Report by Sue Woodger for February 2017

Achievements in Last Period

  • The project priority was changed from P2 to P1
  • Risk meeting held with project team on 17 February
  • At end of planning milestone confirmed that Timetabling would be done completely separately as dependent on Euclid rollover and was added as a Should Have to this project so it does not hold up delivery of 4 building blocks that come under the TEL043 project
  • The upgrade is complete for Dev. Just need agreement for when to move it to Test.
  • Two building blocks are working in Learn after upgrading to latest version of Spring

Issues

  • End of planning was rejected by WIS on 6 February as they thought the costs were too high as they were only 15 days last year. This year however it is a project with additional work over and above the Learn upgrade. PM consulted with Iain Fiddes and resubmitted with costs broken down and was approved by WIS on 17 February.
  • The Learn upgrade itself was delayed by a week while developers worked to resolve issues in the Dev environment before the Learn upgrade itself could be fully completed (See Piccl 4). This also delayed the start of the Building Block work. The developer has been working locally on the BBs but now needs the Dev environment to continue. This should not affect the overall Build milestone of 10 April.
  • Issue with the cumulative patch. It is unsure whether it is for this version of Learn and LTW are following up with BlackBoard. It can be easily applied at any time after we get a response from Blackboard.
  • Two building blocks are not working in Learn after upgrading to latest version of Spring. They work in previous version and developer is investigating to find out the cause of the issue.

Next Steps

  • Resolve Dev environment issues
  • Complete Learn Upgrade and Building Blocks upgrade

TEL044

Pebblepad Upgrade

Compliance

Milestones

TBA

RAG Status: GREEN

Report by Colin Forrest for February 2017

Achievements in last period

  • An initial meeting was held with the Service Manager for PebblePad to cover the requirements of this project.
  • Mari Cruz Garcia Vallejo has been acting as the project manager for the upgrade, preparing the project timeline and plan. Mari Cruz was off at the for the initial meeting and a catch up with Mari Cruz is scheduled for the 09th of March.
  • Mari Cruz has already established the non-technical tasks and workload related to the upgrade and these will be included in the brief for sign off.
  • ​A planning meeting has been arranged.
  • June the 20th has been agreed as the upgrade date for PebblePad.
  • The upgrade will not impact any of the databases.  It will add front end functionality and an updated style.
  • The service is not hosted by the UoE so simplifies the technical challenges within the project.

Issues

  • It should be noted that this is a compliance project with a fixed delivery.  Any delay to the upgrade risks an amount of reputational damage for the University.

Next steps

  • Finish planning and analyse our TEST environment to establish what preparations and tests are possible using this environment.

TEL045

Annual Moodle Upgrade

Compliance

Milestones

TBA

RAG Status: GREEN

Report by Colin Forrest for February 2017

Achievements in last period

  • An initial meeting with the Service Manger to establish the requirement for this year's upgrade.
  • We are moving to 3.2 from 3.1.  This is seen as a lower risk move that should not require a change in infrastructure or deployed environment (such as PHP version)
  • The brief has been drafted, along with the plan.
  • The Service Manager has drafted the BRD.
  • A planning meeting has been arranged.
  • Part of the work this year will be to develop a CSS theme for Moodle version 3.2.

Issues

  • Although timing is critical with this compliance upgrade of Moodle we have the documents in place to push forward as is expected.

Next steps

  • Sign off planning and update DEV.



Section Four: Closed or Withdrawn Projects



Project Info Project Managers Commentary

TEL029 (AP56-080)

Adaptive Learning Pilot

Closure Approved 12/08/16

TEL030 (AP56-013)

Annual Moodle Upgrade

Closure Approved 12/08/16

TEL025

Moodle Course Enrolment Management



Closure Approved 02/09/16

TEL032

BlackBoard Collaborate MyEd Channel Refresh

Closure Approved 09/09/16

TEL039

WebPA Migration

Closure Approved 09/12/16
