Report for April 2018

Report Date
April 2018

Report compiled by Muriel Mewissen (IS Apps Programme Manager)

for Jim McGeorge (USG), Kate Brook (D&A), Jenny Shaw (D&A), Stefan Kaempf (IS Applications), Ian Sutherland (SRA), Jim Galbraith (GaSP) and other interested business area owners.

Section One: Programme Commentary, RAG and Resources Update

Commentary

Please note that the project RAG status is following the guidelines available on the Project RAG status guidance page.

Overall the USG Other Programme is AMBER,  with three active projects, one delayed by external supplier (USG002) and one suspended (USG011) due to internal resource conflict.  The utilisation rate remains low due to the slow progress in USG002 and USG011 as mentioned. USG010 recently started and  work is expected to increase in coming weeks. The contingency held within the USG Other Programme (32d as programme contingency and 55d as portfolio contingency) is expected to be released in support of compliance work in Human Resources.

USG002 - AMBER - due to vendor not delivering on agreed date of 19-Mar-18, instead expecting to be now in early May with an expected knock-on delay to the closure date. Delivery ahead of 25-May-18 remains feasible and likely.  While the risk remains for the potential that consent may need to be sought if legitimate interest is no longer a viable proposal this is now very low probability.

USG010 - GREEN - project initiated earlier than planned to enable the room allocation issue to be resolved: likely alternative space identified in Argyle House.

USG011 - SUSPENDED - Suspension due to resource conflict with higher priority projects.

Forward Look - April 2018

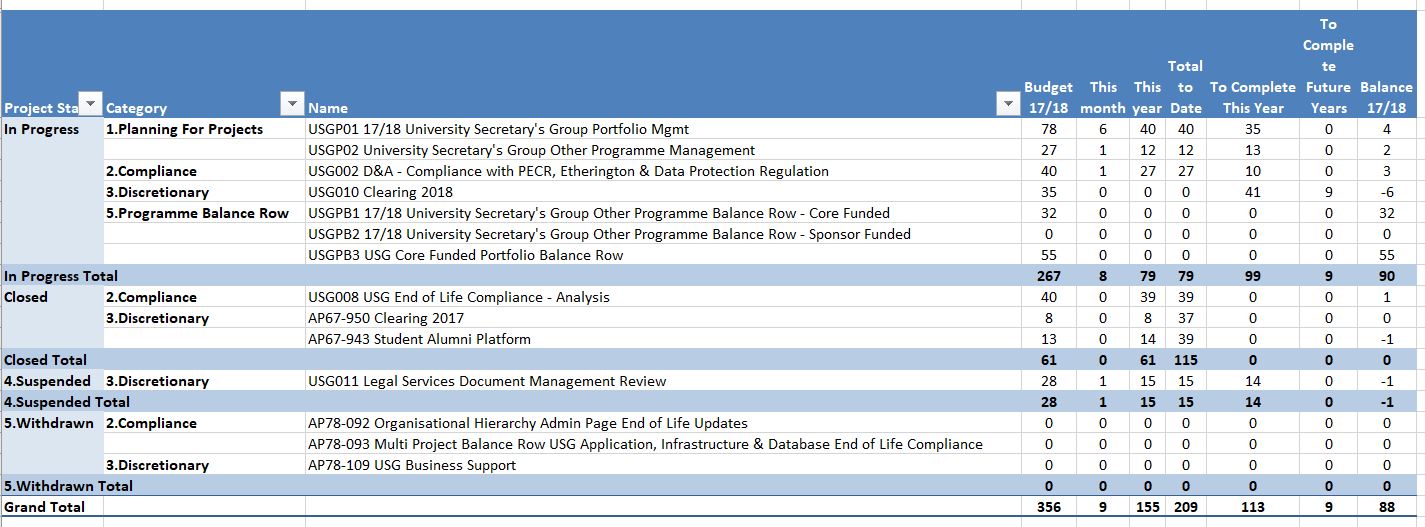

Resources to end April 2018:

Section Two: Projects Not Started

Project Info Programme Manager's Commentary
N/A All planned projects are currently in progress.

Section Three: Projects in Progress

Project Info Project Managers Commentary
USG002 D&A - Compliance with PECR, Etherington & Data Protection Regulation

Category: Discretionary

Milestones

01-May-2018 Build/development work completed
11-May-2018 Acceptance sign-off
22-May-2018 Delivery of updates into Live
29-May-2018 Delivery sign-off
08-Jun-2018 Project closure
RAG Status

AMBER

Report by David Watters for April 2018

Achievements

  • None

Issues

  • Build/development work was not completed; the vendor is now expected to deliver the changes in early May hence AMBER status.

Next steps

  • Receive delivery of solution from vendors
  • Test delivered solution against requirements
  • Implement changes into Live

USG010 Clearing 2018

Category: Discretionary

Milestones

Target Date Title
26-Apr-2018 End of Planning
RAG Status

SUSPENDED

Report by Emma McNab for April 2018

Achievements

  • Initiation Meeting

Issues

  • None

Next steps

  • Project  and Team Initiated
  • Project Brief
  • Project Plan
  • SharePoint site Refresh
USG011 Legal Services SharePoint Site

Category: Discretionary

Milestones

Target Date Title
09-Mar-2018 End of Planning
17-Apr-2018 Build Complete
30-Apr-218 UAT Complete
14-May-2018 Go Live
29-May-2018 Closure Report
RAG Status

GREEN

Report by Geoff Cropley for April 2018

Achievements

  • Project Suspended.
  • A decision has been made to temporarily suspend the project.
  • There are higher priority projects competing for the key project resource including DTI, HR Core, DMS and BAU workload.  The project will be suspended until there is a full workload pipeline produced that incorporates realistic estimates for when the work can be completed and appropriate milestones set.  This review will be complete by 31st May 2018.
  • This decision has the backing of the Business Lead, Project Sponsor and Programme Manager.

Issues

  • None

Next steps

  • Complete pipeline analysis by 31st May 2018

Section Four: Closed or Withdrawn Projects

Project Info Project Managers Commentary

AP78-092 Organisational Hierarchy Admin Page End of Life Updates

Category: Compliance

Report by Sheila Fraser

This project was withdrawn on 06-Oct-17.

USG006 Clearing 2017

Category: Discretionary

Report by Emma McNab

This project was closed on 15-Sep-17.

Please see the Closure Report for further information.

USG005 Student Alumni Platform

Category: Discretionary

Report by David Watters

This project was closed on 18-Jan-18.

Please see the Closure Report for further information.

USG Business Support

Category: Discretionary

Report by Sheila Fraser

This project was withdrawn on 02-Feb-18.

USG008 USG End of Life Compliance - Analysis

Category: Compliance

Report by Sheila Fraser

This project was closed on 07-Mar-18.

Please see the Closure Report for further information.

Multi-Project Balance Row USG Application, Infrastructure & Database End of Life Compliance

Category: Compliance

Report by Sheila Fraser

This project was withdrawn on 09-Mar-18.
