Report compiled by Sheila Fraser (IS Apps Programme Manager)

for Jim McGeorge (USG), Grant Spence (D&A), Jenny Shaw (D&A), Simon Raeside (Careers), Shelagh Green (Careers), Stefan Kaempf (IS Applications), Ian Sutherland (SRA), Jim Galbraith (GaSP) and other interested business area owners.



Section One: Programme Commentary, RAG and Resources Update

Commentary

Overall the USG Other Programme is GREEN, as it is expected that planned essential work can be completed in this year. This is GREEN with the note that the utilisation rate is low due to:

  1. The contingency held within the USG Other Programme (32d as programme contingency and 55d as portfolio contingency).
  2. Work started early in USG010, which will increase in the coming weeks.
  3. If the above items are removed from the budget the utilisation rate is running at 93% for the year to date.

USG002 - AMBER - due to vendor not delivering on agreed date of 19-Mar-18, instead expecting to be early April with an expected knock-on delay to the closure date. Delivery ahead of 25-May-18 remains feasible and likely.  While the risk remains for the potential that consent may need to be sought if legitimate interest is no longer a viable proposal this is now very low probability.

USG010 - GREEN - project initiated earlier than planned to enable the room allocation issue to be resolved: likely alternative space identified in Argyle House.

USG011 - AMBER - delivery likely to be delayed due to under-estimation of work involved, increase in complexity of solution required, and prioritisation of GDPR SharePoint work. Risk of estimate increase.

USG008 - BLUE - Closed with a 1-slide summary here and the closure report here.

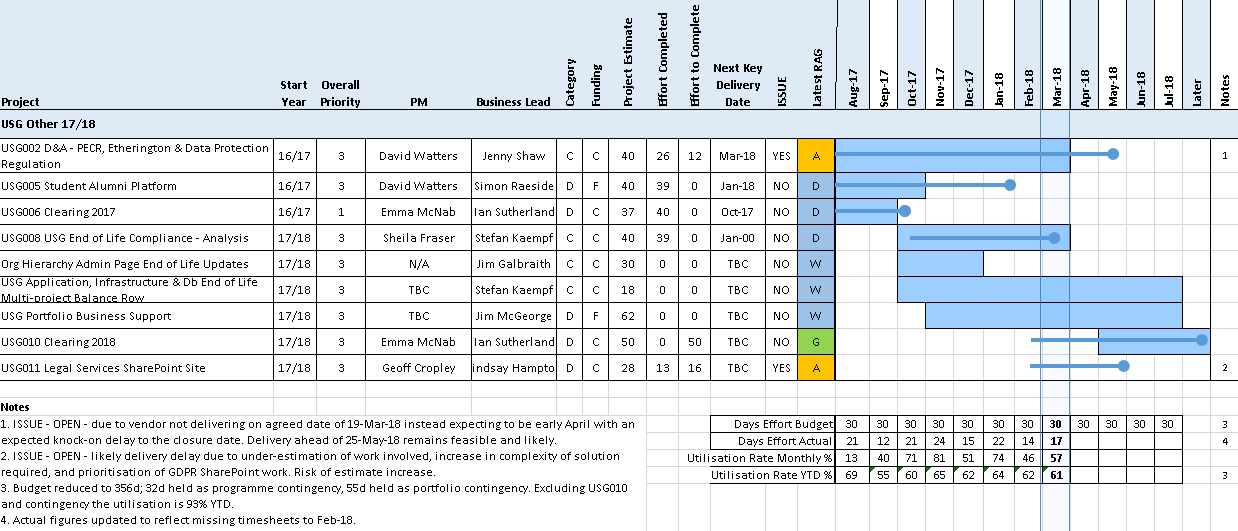

RAG & Forward Look

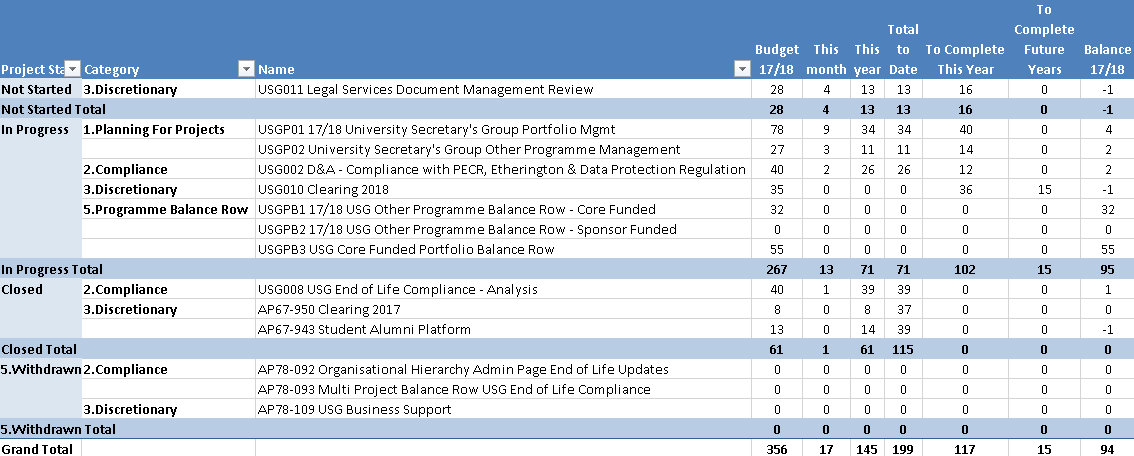

Resources to end of March 2017

In the table below the USG011 is showing as Not Started, this is erroneous, the project is In Progress, and will be rectified ahead of the next reporting period.

Section Two: Projects Not Started

Project Info Programme Manager's Commentary
  All planned projects are currently in progress.



Section Three: Projects in Progress

Project Info Project Managers Commentary

USG002 D&A - Compliance with PECR, Etherington & Data Protection Regulation

Category: Discretionary

Milestones

19-Mar-2018 Build/development work completed
09-Apr-2018 Acceptance sign-off
12-Apr-2018 Delivery of updates into Live [Provisional]
20-Apr-2018 Delivery sign-off [Provisional]
04-May-2018 Project closure [Provisional]

RAG Status

AMBER

Report by David Watters for March 2018

Achievements

  • Further discussion round Privacy Notices & Announcements

Issues

  • Issue 6 - open - Build/development work was not completed on 19-Mar-2018; the vendor is expected to deliver the changes in early April hence AMBER status.

Next steps

  • Build/development work completed
  • Receive delivery of solution from vendors
  • Test delivered solution against requirements

USG011 Clearing 2018

Category: Discretionary

Milestones

26-Apr-2018 End of Planning

RAG Status

GREEN

Report by Emma McNab for March 2018

Achievements this Period

  • Project Approved

Issues

n/a

Next Steps

  • Project  and Team Initiated
  • Project Brief
  • Project Plan
  • SharePoint site Refresh

USG011 Legal Services SharePoint Site

Category: Discretionary

Milestones

02-Mar-2018 End of Planning

RAG Status

AMBER

Report by Geoff Cropley for March 2018

Achievements

  • New project manager appointed
  • End of planning approved on 23rd March 2018

Issues

  • Issue 3 - open - delays to build due to under-estimation of work involved, increase in complexity of solution required, and prioritisation of GDPR SharePoint work.
  • Issue 4 - open - likely delay to subsequent agreed milestones due to delay to delivery

Next steps

  • Complete build work and agree sign-off
  • Agree new plan for deployment and closure milestones



Section Four: Closed or Withdrawn Projects

There are no projects that have been closed or withdrawn in 17/18 to date.

Project Info Project Managers Commentary

AP78-092 Organisational Hierarchy Admin Page End of Life Updates

Category: Compliance

Report by Sheila Fraser

This project was withdrawn on 06-Oct-17.

USG006 Clearing 2017

Category: Discretionary

Report by Emma McNab

This project was closed on 15-Sep-17.

Please see the Closure Report for further information.

USG005 Student Alumni Platform

Category: Discretionary

Report by David Watters

This project was closed on 18-Jan-18.

Please see the Closure Report for further information.

USG Business Support

Category: Discretionary

Report by Sheila Fraser

This project was withdrawn on 02-Feb-18.

USG008 USG End of Life Compliance - Analysis

Category: Compliance

Report by Sheila Fraser

This project was closed on 07-Mar-18.

Please see the Closure Report for further information.

Multi-Project Balance Row USG Application, Infrastructure & Database End of Life Compliance

Category: Compliance

Report by Sheila Fraser

This project was withdrawn on 09-Mar-18.



Documentation

Not available.
