October 2017

Report Date
October 2017

Report compiled by Sheila Fraser (IS Apps Programme Manager)

for Jim McGeorge (USG), Grant Spence (D&A), Jenny Shaw (D&A), Simon Raeside (Careers), Shelagh Green (Careers), Stefan Kaempf (IS Applications), Ian Sutherland (SRA), Jim Galbraith (GaSP) and other interested business area owners.



Section One: Programme Commentary, RAG and Resources Update

Commentary

Overall the USG Other Programme is AMBER, as there is still one potential project that may need to be included in the USG portfolio for completion ahead of the May 2018 GDPR deadline that is not currently in the plan.

  1. As a result of Risk 14 being raised it has been agreed to initiate STU259 with an estimate of 30d to make the changes for new request types and for how the response due date is calculated. STU259 has been initiated in the Student Administration Services programme, and so the risk is closed in USG Other.
  2. Risk 15 has been raised for a similar issue, and after some discussion it has been agreed this should be a compliance project, and funding should be taken from the USG portfolio contingency. A project will be initiated in the Student Administration Services programme in November for this work. Risk 17 has been raised to reflect the increased risk that Records Management are not resourced to manage the increase in expected workload for these two unplanned compliance projects.

USG002 - GREEN/AMBER - the analysis has identified that the majority of the work will be undertaken by the 3rd party vendor. The estimate for the project is expected to reduce, hence AMBER. The risk remains for the potential that consent may need to be sought if legitimate interest is no longer a viable proposal.

USG005 - AMBER - due to delay to closure as the contract is not yet signed, and correspondingly the subsequent implementation plan is not complete.

USG008 - AMBER - currently in planning phase, early indications of estimate are likely to be higher than the 20d currently allocated - however budget is available from the corresponding multi-project balance row and will be allocated as needed (see yellow shaded cells in Resources table below).

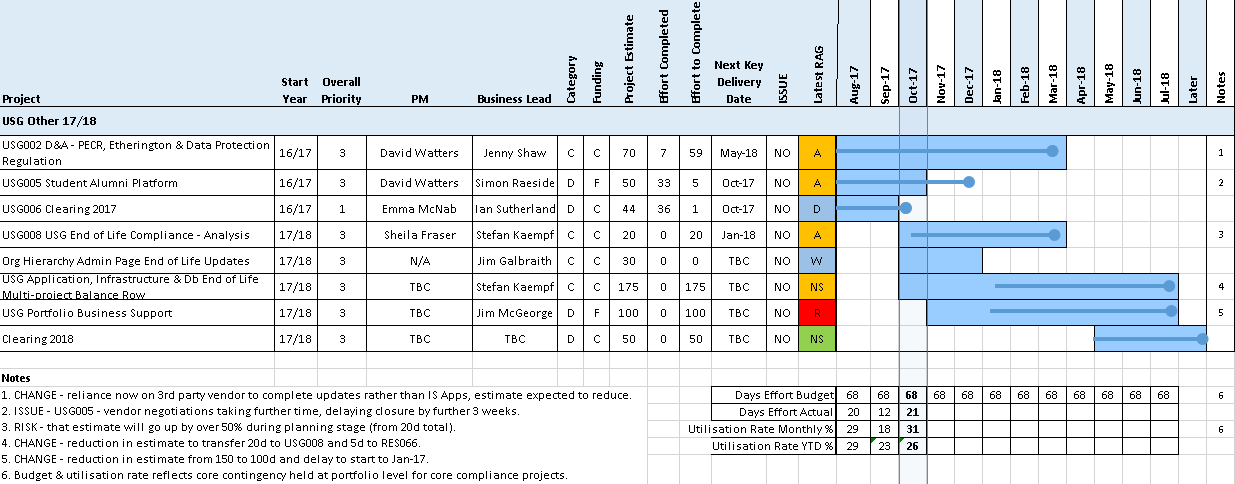

RAG & Forward Look

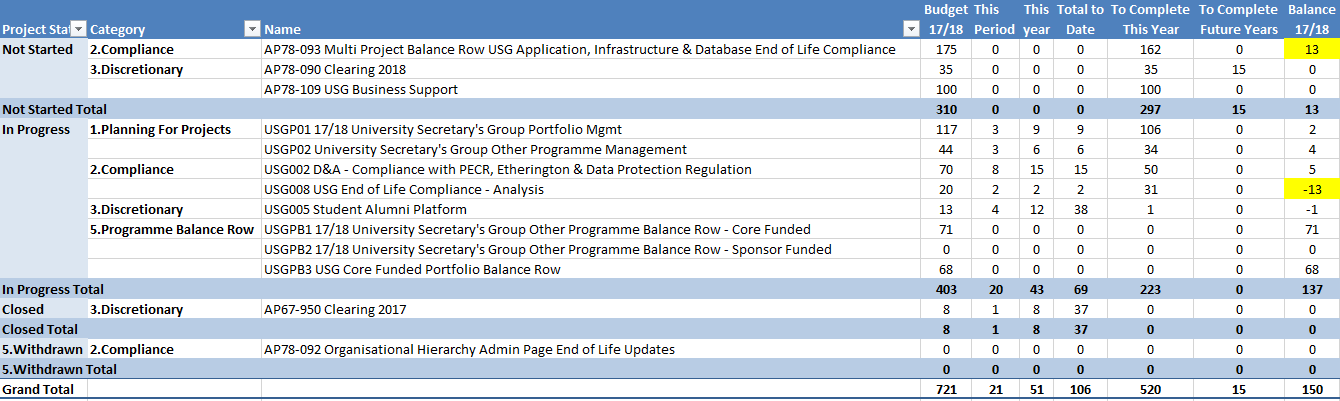

Resources to end of August 2017

USG008 - this is currently in the planning phase and early indications of estimate are likely to be higher than the 20d currently allocated - this is being offset from the corresponding multi-project balance row as indicated by the yellow shaded cells below. The USGPB1 and USGPB3 balance rows are likely to be needed to fund the unplanned work for Records Management noted in Risk 15.

Section Two: Projects Not Started

Project Info Programme Manager's Commentary

Multi-Project Balance Row USG Application, Infrastructure & Database End of Life Compliance

Compliance

Planning: October 2017

Delivery: July 2018

RAG Status

AMBER

Plan

There is a need to identify applications, databases and infrastructure which will come to the end of their working life in the next 3 years, and to plan upgrades, migrations or replacements accordingly.

This project has started in October for business analysis in USG008; further work will be on a call-off basis from this balance row if a need is identified for urgent work in 17/18 during USG008.

This is AMBER due to the change in allocation from 200d to 175d in November 2017.

Dependencies

Clarity on end of life position from Production Management for each component of the architecture.

Discussion with Service Excellence regarding planning and timelines for USG applications in SEP scope.

USG Business Support

Discretionary

Planning: January 2017

Delivery: July 2018

RAG Status

RED

Plan

This project is to provide a basis of days on which a call-off can be made for areas of priority for USG, in a similar manner to that of the ring-fence for the Colleges. As such there is no immediate clarity on the scope, this is most likely to be a number of small pieces of business analysis, with potential follow-on work dependent on the outcomes of the analyses.

This is RED as the allocated budget has reduced from 150d to 100d, and the start date has been delayed to January - as no work has yet been identified.

Dependencies

None known.

Clearing 2018

Compliance

Planning: May 2018

Delivery: August 2018

RAG Status

GREEN

Plan

The University will likely enter UCAS clearing again for 2018 with places being available to prospective students from Scotland and the rest of the UK (rUK)

The project will start in May 2018 to ensure we are ready.

Dependencies

Decision from the University to enter Scottish and rUK Clearing in 2018.



Section Three: Projects in Progress

Project Info Project Managers Commentary

USG005 Student Alumni Platform

Category: Discretionary

Milestones

27-Nov-2017                              Procurement stage sign-off                                       Procure
08-Dec-2017 Closure report completed Close

RAG Status

AMBER: final milestones have been delayed by a few weeks.

Report by David Watters for October 2017

Achievements

  • Remaining sections of contract worked out between UoE and vendor (now under final review)
  • Plans for implementation started

Issues

  • Completion date extended by a few weeks because of delay in completing final contract

Next steps

  • Sign-off final version of contract
  • Complete post-ITT checklist
  • Finalise plan for follow-on implementation project

USG002 D&A - Compliance with PECR, Etherington & Data Protection Regulation

Category: Discretionary

Milestones

17-Nov-2017 Analysis & Design completed Analyse
19-Jan-2018 Build/development work completed Build
06-Feb-2018 Acceptance sign-off Accept
15-Feb-2018 Delivery of updates into Live [Provisional] Deliver
23-Feb-2018 Delivery sign-off [Provisional] Deliver
23-Mar-2018 Project closure [Provisional] Close

RAG Status

GREEN

Report by David Watters for October 2017

Achievements

  • Business analysis completed
  • Preliminary consultation with Notifications project team to consider a solution for notices

Issues

  • None

Next steps

  • Pass requirements analysis to vendor for development work
  • Continue work on a solution for business processes
  • Commence system design as required







USG008 USG End of Life Compliance - Analysis

Category: Compliance

Milestones

24-Nov-2017 End of Planning

RAG Status

AMBER

Achievements

  • Project initiated
  • Business Analyst assigned and analysis initiated
  • Project brief drafted for circulation

Issues

  • Initial estimates from Project Services, Software Development and Development Technology indicate that the project is likely to take more than the 20d estimated at initiation

Next steps

  • Complete estimate, plan and sign off project brief
  • Undertake Business Analysis of initial systems



Section Four: Closed or Withdrawn Projects

There are no projects that have been closed or withdrawn in 17/18 to date.

Project Info Project Managers Commentary

AP78-092 Organisational Hierarchy Admin Page End of Life Updates

Category: Compliance

Report by Sheila Fraser

This project was withdrawn on 06-Oct-17.

USG006 Clearing 2017

Category: Discretionary

Report by Emma McNab

This project was closed on 15-Sep-17.

Please see the Closure Report for further information.
