April 2014
- Report Date
- April 2014
Report compiled by Sheila Fraser (IS Apps Programme Manager)
Section One: Programme Commentary, RAG and Resources Update
Sheila Fraser has resumed her role of Programme Manager for Other SASG Portfolio Projects following return from maternity leave. Thanks to Jamie Thin for taking on this role over the past year.

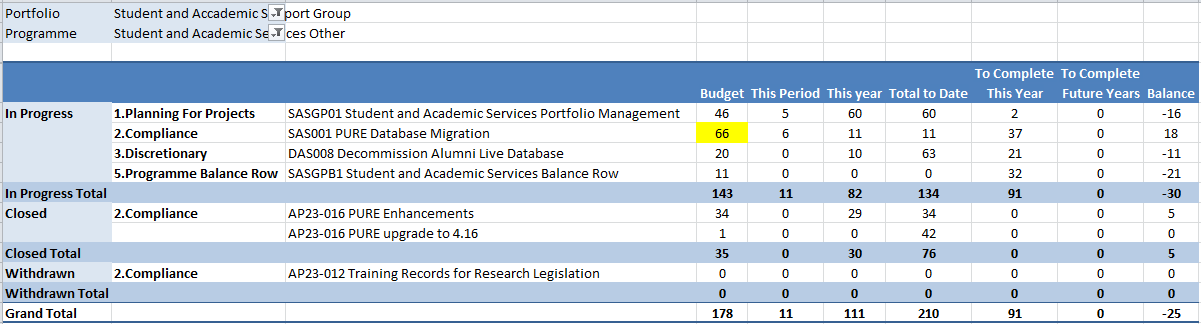

The overall programme status is RED as the expected work to complete is higher than the available budget. The table below does not reflect the last approved budget, but rather that which is expected to be needed for the two projects in progress. Options on scope of projects in progress and budget will be discussed at the next portfolio status meeting.
SAS001 is RED as the agreed budget is 20d, and the latest estimate for the work required is 66d.
DAS008 is technically RED as no project manager was assigned during the last months, so milestones are past without update. However, it is expected that the project will be able to deliver the decommissioning before the drop dead date for the infrastructure as it is expected that a 2 week concentrated period would enable all actions to complete, and so the project is overall AMBER as the resources for this are not yet booked. This will be progressed in May.


Section Two: Projects Not Started
Project Info | Project Managers Commentary |
Section Three: Projects in Progress
| Project Info | Project Managers Commentary | ||||
| Report for April 2014 by Sally HaywardAchievements in Last Period
Issues
Next Steps
The project is currently showing a RED status as the planning phase is overdue and the scope has increased from the original project proposal. This should rectify once governance has approved the changes.
| ||||
Decommission Alumni Live Database
Category: Core Milestones Previous milestones are past; RAG Status AMBER | Report for April 2014 by Sheila Fraser (Programme Manager acting in lieu of Project Manager) Achievements in Last Period
This project is technically RED as no project manager was assigned during the last months, so milestones are past without update. However, it is expected that the project will be able to deliver the decommissioning before the drop dead date for the infrastructure as it is expected that a 2 week concentrated period would enable all actions to complete, and so the project is overall AMBER as the resources for this are not yet booked. This will be progressed in May. |
Section Four: Closed or Withdrawn Projects
Pure Enhancements Compliance | Report by Sue Woodger This project was closed on 20-Jan-14 Please see the Completion Report for further information |
