Report for May 2018

Report Date
May 2018



Report compiled by Andrew Stewart (IS Apps Programme Manager) for David Montgomery(Programme Owner)



Section One: Programme Commentary, RAG and Resources Update

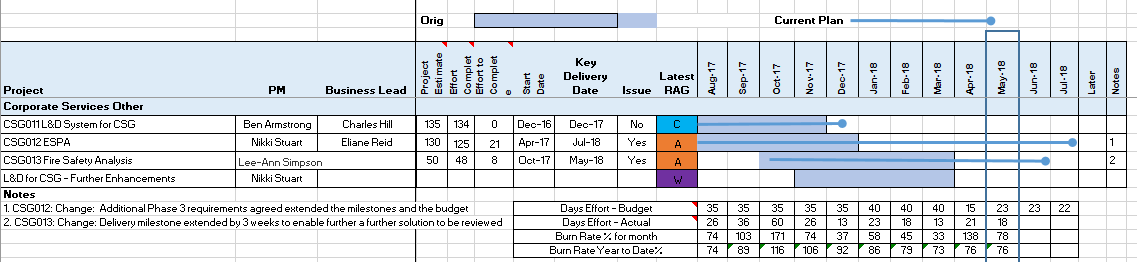

Forward Look

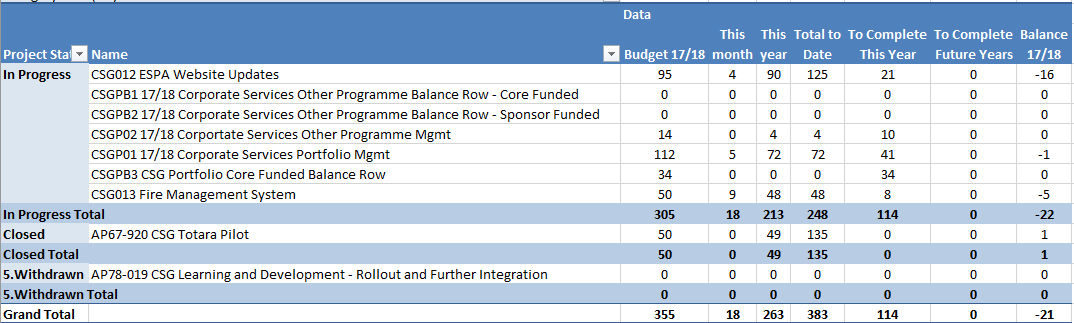

Resources Position







Section Two: Projects Not Started

There are no not started projects currently planned for 17/18.

Project Info Programme Manager's Commentary









Section Three: Projects in Progress

Project Info Project Managers Commentary

CSG012

ESPA

Category: Discretionary (Sponsor funded)

 Remaining Milestones



15-June-2018 Phase 3 - Build Sign Off
20-June-2018 Phase 3 - UAT Sign off
27-Jun-2018 Phase 3 - Deployment to LIVE
27-Jul-2018 Phase 3 - Deployment Sign Off
27-Jul-2018 Project Closure



RAG Status : AMBER



Report by Nikki Stuart for May 2018

Achievements in the last period

  • Phase 3 graphic design completed and signed off
  • TEST and STAGING refreshed
  • Sql upload completed and signed off in LIVE
  • Phase 3 build estimate provided
  • Agreement reached between ESPA and Apps over developer costs

Issues

  • none

Next steps

  • Build Phase 3 enhancements
  • start UAT for Phase 3 enhancements
  • deployment to LIVE for Phase 3

RAG - AMBER - CHANGE: Additional Phase 3 requirements agreed extended the milestones and budget.





CSG013

Fire Safety Analysis

Category: Discretionary (Sponsor funded)

 Milestones

  Title
15-Jun-2018 Analysis
29-Jun-2018 Delivery
13-Jul-2018 Closure

RAG Status : AMBER

Report by Lee-Ann Simpson for May 2018



Achievements in the last period

  • Archibus webinar held on 18th May for the Fire Safety demonstration.
  • Completed gap analysis review once Fire Safety demo has been undertaken with regards to:
    • Existing Archibus modules
    • Potential market supplied solutions
  • Continued business report.
  • ARUP supplier demonstration for the Fire Safety Team held on 10th May.
  • Reviewed requirements with Fire Safety team and determined they were all still in scope.
  • Last minute demonstration held with FCS to review their product and include in the business analysis.

Issues

  • Last minute demonstration of 3rd party provider requested by business lead has delayed the finalised business analysis and may push the project over budget.

Next Steps

  • Complete business analysis to include FCS demonstration.
  • Finalise business analysis  and prepare recommendations.
  • Provide recommendations to the project team.
  • Create closure report.
  • Close project.

Rag Status: Change: Delivery milestone extended by  weeks to enable a further solution to be reviewed



 Section Four: Closed or Withdrawn Projects

Project Info Project Managers Commentary

CSG011

Totara Pilot

Category: Discretionary (Sponsor funded)

Project closed Jan 18. Closure Report can be found at https://www.projects.ed.ac.uk/project/csg011/closure-report

CSG Learning & Development - Rollout and Further Integration;

Category: Discretionary (Sponsor funded)

Withdrawn following decision not to roll out the L&D system. See closure report for CSG011 above for information.
