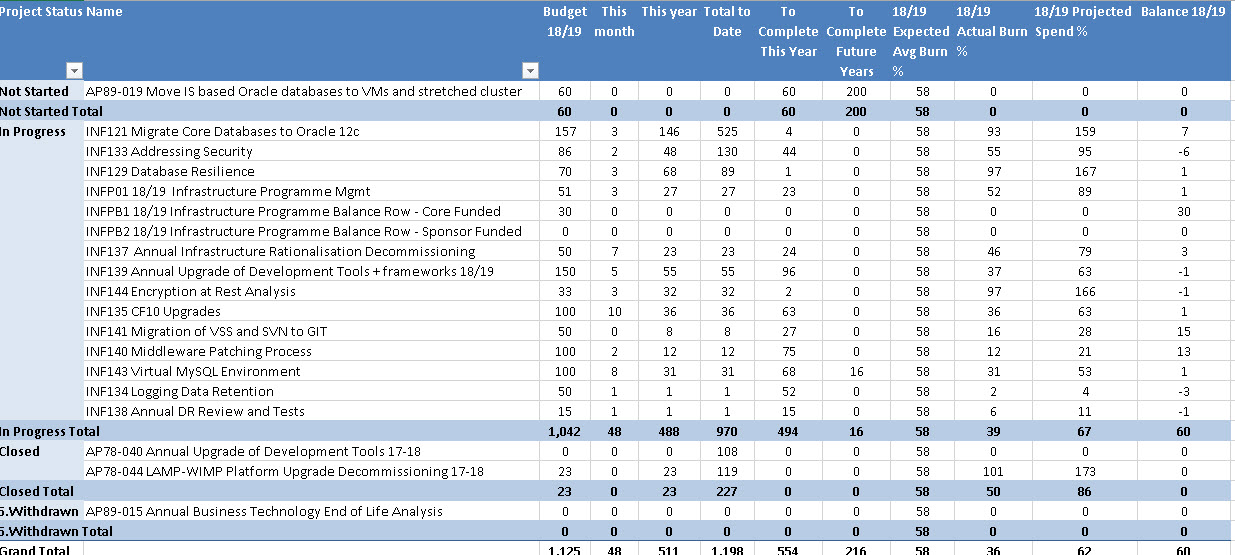

Project Info
|
Project Manager's Commentary
|
INF121 (17-18 project)
Migrate Core Databases to Oracle 12c
Milestones
RAG Status
GREEN
|
Report by David Watters for February 2019
Achievements this Period
- Work on 'mopping up' tasks continued
Issues
Next Period
|
INF129 (17-18 Project)
Database Resilience 17-18
Milestones
RAG Status
AMBER - replan of milestones finalised.
|
Report by David Watters for February 2019
Achievements This Period
Issues
- Outstanding milestones to be revised
- Extra effort required to complete project
Next Steps
|
INF134 AP89-023
Logging Data Retention
Milestones
To be determined during planning
RAG Status
GREEN
|
Report by Colin Watt for February 2019
Achievements in Last Period
- Project Sponsor and Team kickoff meeting w/c 11/02/19.
- Project brief and estimates in draft.
Issues
- No major issues. Time constraints on project team for completing planning, but no concerns once planning agreed.
Next Steps
- Complete project brief and estimates.
- Agree scope and sign off planning milestone with TechMan, DevTech, ITI on planning and estimates.
|
INF135
CF10 Updates
Milestones
RAG Status GREEN
|
Report by Sue Woodger for February 2019
Achievements in last period
- Reviewed costs and plan for development work with programme manager 20 Feb 19
- DevTech completed Dev build on KB server and modified Bamboo on Dev for Cesar and AIR. Cesar will be the proof of concept application
- DevTech have spent a lot of time (10d) getting Puppet ready – but this has included the building of the Dev server, updated the settings and updated the documentation. This work now has to be signed off by Dev team before DevTech can continue with the build
- DevTech found an issue with one of the frameworks (Coldspring) and put a manual fix on the server and needs someone in Dev to put into version control and create a Bamboo plan. He also needs advice from Dev Team on what branch should be used etc
Issues
- Submitted request for development resource on 6 February and this was answered by resourcing manager on 7/2 that the developer has no time until April. PM then asked who else could do this work but received no reply. PM tried to follow up but resourcing manager was on leave. PM emailed for his return on 18/2 stating that he hadn’t informed who could do this work – PM pointed out that the booking was still in asta and if he couldn’t assign it all can he assign the urgent work (as detailed to him i.e. the work identified in achievements section above) . PM followed this up on 20//192 as still no reply. PM was then copied into an email to developer assigning his time from 1 March to 18 April. There was no acknowledgement of the urgent work to be done to allow continuation of build. This means that work on build cannot continue until after developer has completed those urgent tasks wef 1/3/19. This has delayed build work and revised milestones had to be submitted to WIS 20/2/19.
Next Steps
- Developer to start in urgent tasks wef 1 Mar
- This will then allow DevTech to continue with build work
|
INF137
Annual Infrastructure Rationalisation Decommissioning
Milestones
RAG Status
GREEN
|
Report by David Watters for February 2019
Achievements
- Identification of Windows 2012 servers/business owners
- Cross-checking with ENT023 project finalised
- More work on Windows 2008 outstanding items
Issues
Next steps
- Final work on server listings
- Communications with Windows 2012 servers/business owners
- Checking of RedHat 6 servers
- Planning of any decommissions that are 'orphaned'
|
INF138 AP89-017
Annual DR Review and Tests
Milestones
To be determined during planning
RAG Status
GREEN
|
Report by Colin Watt for February 2019
Achievements in Last Period
- Project Sponsor and Team kickoff meeting w/c 11/02/19.
- Project brief and estimates in draft.
- PM discussion with PM of ENT038 - PM added to INF138 as stakeholder
Issues
- No major issues. Time constraints on project team for completing planning, but no concerns once planning agreed.
Next Steps
- Complete project brief and estimates.
- Agree scope and sign off planning milestone with TechMan, DevTech, ITI on planning and estimates.
|
INF139 Annual Upgrades of Development Tools + frameworks 18/19 (18-19 Project)
AP89-018
Milestones
RAG Status
GREEN
|
Report by Anne Mathison for February 2019
Achievements
- Due to key PMO ASTA project team absences the ASTA milestones have had to be delayed until March
- ASTA requirements completion delayed until March to allow more time
- ASTA - milestone dates have been amended and agreed with the ASTA programme
- This may still be further delayed as initial talks with supplier have not been arranged as yet
- Nexus has been deployed to Test
Issues
Next Steps
-
Resolve a misconfiguration issue between Python version as configured on infrastructure vs Python version as configured on build / deployment.
- Once above resolved, update Python documentation re Bamboo plan configuration.
- Python QA to complete - Puppet Code will go in first (Dev Tech) and Bamboo plan follows after that (Software Dev)
-
Hand over Python work to Apps Support
- Completion of documentation updates
- Sign off Python Acceptance Testing in March
-
Deploy Python during March
- ASTA versions to be discussed with the supplier
- ASTA requirements will be completed in March
- ASTA JIRAs to be set up for the tasks required
- Review Nexus and update test coverage in Test
- Apply upgrade to Test
- Test processes in Test
- Acceptance Signoff in Test
- Review schedule, possibilities and downtime impact
- Agree and schedule Nexus Go Live
- Set up Service Alert for Nexus
- Set up Go Cab for Nexus
- Nexus deployed to LIVE
- Bamboo upgrade work will start in March
- Bamboo Acceptance Testing will be virtually complete
GREEN RAG status
|
INF140 - Middleware Patching Process
Milestones
05-April-2019 M3: Patch Strategies Complete
24-April-2019 M4: Initial Patch Cycle Complete
07-June-2019M5: Delivery
28-June-2019 M6: Project Close
RAG Status
GREEN
|
Report by Karen Stirling for February 2019
Achievements in Last Period
- Template created for patching process documentation
- Development Team and Tech Man Resources identified
- Patch Strategy document created for Java and Coldfusion
Issues
- Project team have reviewed initial planning milestones and agreed to move project closure out to end of June as there are no key dependencies on project completing by April
- Revised milestones to be submitted to WIS for approval and approved given by Project Sponsor
Next Steps
- Aim to complete priority components in next month and those which are easiest to tackle
The project is reporting GREEN
|
INF141 (18-19 Project)
Milestones
RAG Status
Red
|
Report by Maurice Franceschi for February 2019
Achievements this period
- resource partially assigned - up to April
- PM was not changed
Issues
- software development resources booked - still not fully resourced
Next Steps
- resourcing up to end of June
- continue with priority list of Apps
|
INF143 - MySQL Environment Migration
Milestones
02-Nov-2018 End of Planning 05-Jun-2019 Deployment Sign-off 26-Jun-2019 Project Close
Milestones
RAG Status
Green
|
Report by Geoff Cropley for February 2019
Achievements This Period
- Confirmation from OGG the use and migration from MySQL to Maria DB
- Puppet build automation in progress
- Plan and estimate under review with the potential to complete as many applications as possible within the academic year and budget
Issues
Next Steps
- Agree revised application inventory
- Build Development environment using Puppet automation
|
INF144 (18-19 Project)
Milestones
RAG Status
Green
|
Report by Ken Miller for February 2019
Achievements
- Phase 2 scoping exercise to discuss approach and timescales rearranged due to last minute resource conflict.
Issues
Next Steps
- Phase 2 scoping exercise held to discuss approach and timescales.
- Report detailing phase 2 approach and plan forwarded to stakeholders.
- Close project.
|
