September 2015

Report Date
September 2015

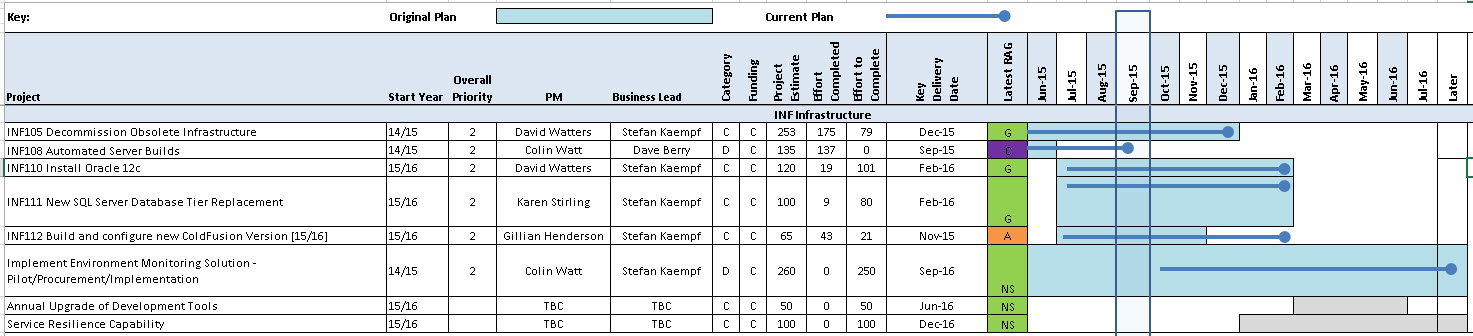

IS Applications Infrastructure Programme Report for Programme Owner Stefan Keampf

Section One: Programme Commentary, RAG and Resources Update

Section Two: Projects Not Started

Section Three: Projects In Progress

Section Four: Closed or Withdrawn Projects



Section One: Programme Commentary, RAG and Resources Update

Overall Programme RAG: GREEN

The programme main projects for first half of yhe year all under way, with planning phase taking longer for some than had been expected. Budgets fine.

The system monitoring pilot project, workign with ITI, will kick off early October.









Section Two: Projects Not Started

Project InfoProgramme Manager's Commentary

System Monitoring Solution - Pilot



INF107 having completed, the next project will split into a Pilot phase to validate the technical solution and the process changes recommended, before procurement/implementation.

We had hoped to start this in 2014/15 but due to other priorities and resource constraints, will start in Q4 2015 once we have discussed with colleagues in ITI.



Service Resilience Capability

Staff and students have been operating more and more on a 24x7x365 basis. Service availability is key to ensure this. While our infrastructure is robust, issues to arise and as we do not have personnel on hand to the same timeframe, an automated facility is required.

To start Q1 2016

Annual upgrades of development tools (JIRA, Bamboo, etc) (15-16)

We have taken on the above products as part of our core workflow for project (and support) delivery in recent times. As such they are essential to our ability to successfully deliver change within the University. Failure to keep the products up to date and in a supportable position exposes us to the risk of serious issues with the software that may affect their ability to run and operate in our environment.

To start Q1 2016



Section Three: Projects in Progress



Project InfoProject Managers Commentary
INF105 (AP45-053)

Decommission Obsolete Infrastructure

Category: Core Funding



Milestones



02-Nov-2015Unix decommissioning (15-16) completedBuild
16-Nov-2015RedHat decommissioning (15-16) completedBuild
30-Nov-2015Recommendations and procedures signed offDeliver
07-Dec-2015Windows decommissioning (15-16) completedBuild
17-Dec-2015ClosureClose

















RAG Status/ RAG change during last month

GREEN

Report by David Watters for September 2015







Achievements this Period

  • Clarification round CF applications to be migrated - checked with Programme Managers
  • Work on Password Manager now almost complete

Issues

  • Uncertainty for some staff with regards to what applications need to be migrated
  • Need to update later milestones in line with migration projects in other programmes

Next Steps

  • Sign off deployment of Password Manager
  • Update milestones and risks round CF migrations





INF110 (AP56-004)

Install Oracle 12c

Category: Compliance



Milestones

30-Oct-2015Analysis & Design sign-offDesign
16-Dec-2015Build sign-offBuild
27-Jan-2016Acceptance sign-offAccept
04-Feb-2016Deployment to LIVEDeliver
11-Feb-2016Deployment sign-offDeliver
25-Feb-2016Project closureClose



RAG Status/ RAG change during last month

GREEN

Report by David Watters for September 2015







Achievements this Period

  • Project brief completed and signed off
  • New servers built by ITI Unix
  • Oracle 12c seminar attended by colleagues and material distributed to project team

Issues

  • Resourcing delayed because of workload conflicts for PM

Next Steps

  • Server build to be continued by Dev Tech staff
  • Training and familiarisation to continue

INF111 (AP56-006)

New SQL Server Database Tier Replacement

Category: Compliance



Milestones

09-Oct-2015Project Brief















RAG Status/ RAG change during last month

GREEN, no change

Report by Maurice Franceschi for Karen Stirling for September 2015

Programme Manager comment Karen is off w/c 5th Oct., but project brief has already been submitted to WIS and with some clarifications, will be accepted by WIS for the 9th October deadline.



Achievement in Last Period

  • Planning and Resource allocation - done
  • Identify further stakeholders - done
  • Review consultancy work required and request resource - done
  • Project Brief approval - not achieved





Milestones

Planning 9th. October

Next Steps

  • Project Brief approval
  • start analysis design
  • bring in consultants to assist analysis and design



INF112 (AP56-007)

Build and Configure new ColdFusion Version [15/16]

Category: Compliance



Milestones

30-Oct-2015Acceptance Review
17-Nov-2015Delivery
27-Nov-2015Deployment Sign Off
11-Dec-2015Closure















RAG Status / RAG change during last month

AMBER





Report by Gillian Henderson for September 2015



Note from Programme Manager- RAG Status Amber Status moved to Amber during the last period, as resources were re-allocated to a priority 1 project. The plan has been re-cast and new milestones are in place, so that project is back on track and status will be Green again next month.



Achievements in Last Period

  • Complete build of Dev CF11 Environment.
  • Complete Migration of dev Application to validate CF11 - iSkills
  • Review and agree on standard CF11 config settings
  • Build Implementation plan for CF11 Install created
  • Implementation plan for iSkills migration created
  • Build sign off complete
  • Carry out prep, including requesting VM's for test environment
  • CF11 environment created
  • Prep for iSkills test migration carried out.



Issues

  • The duration of the dev setup tasks for CF11 took longer than anticipated. This was due to resources booked on the project (Mark Dobbing) working on other projects alongside this work and issue configuring CF11 environment. Re-estimation carried out after build sign off and test and live bookings have now been re-planned following on from the conflict and cosign issue encountered in dev. The conflict for Mark Dobbings time has been minimised as the majority of tasks for TTU010 will now be assigned to David McNicoll and Emilio Lopez.
  • The effort for some of the dev tasks was closer to the 95 % estimate due to config issues with new CF version and new Centos OS. All issues resolved and re-estimate of taken place for test and live. Minimal changes to susequent estimates so no changes to overall estimate expected.

Next Steps

  • Migrate iSkills Test environment to CF11
  • Test iSkills following upgrade to CF11
  • Acceptance Sign off
  • DR Test carried out
  • Updates to Operational doc  including DR procedure and creating new Instance in CF11
  • Carry out prep, including requesting VM's for live environment
  • Prep for test iSkills migration carried out.



Section Four: Closed or Withdrawn Projects



Project InfoProject Managers Commentary

INF108 (AP45-034)

Automated Server Builds

Closure approved 11 September 2015.
