March 2015

Report Date
March 2015

Infrastructure Programme Report for Programme Owner David Smyth

Section One: Programme Commentary, RAG and Resources Update

Section Two: Projects Not Started

Section Three: Projects In Progress

Section Four: Closed or Withdrawn Projects



Section One: Programme Commentary, RAG and Resources Update

Overall Programme RAG: GREEN

The current projects remain on course for completion in the year.

There are a number of actions from the INF104 for the programme to progress. These are listed in a dedicated page. https://www.projects.ed.ac.uk/programmepage/30193.

As all the current projects are now in ASTA and resourced, Programme Status is Green.

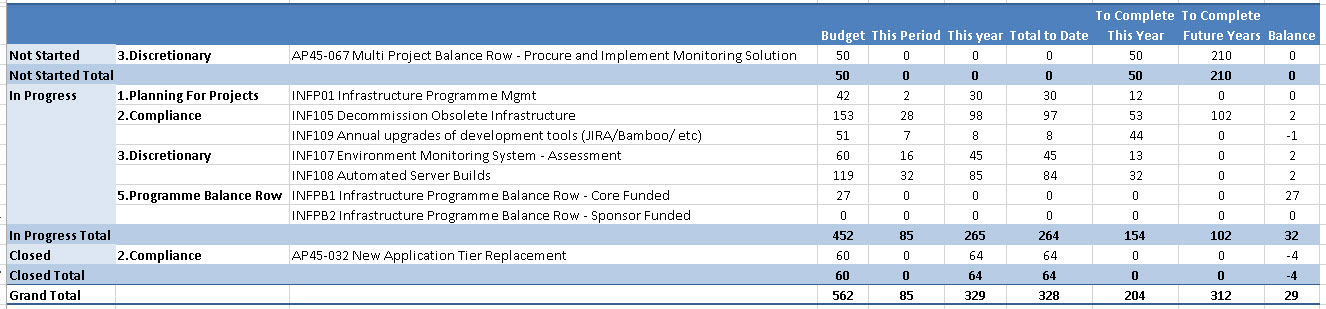

A contingency of 27 days remains available to the programme, and the recommendation is to keep these in case of need in INF105 and to allow some 15/16 project to start early.









Section Two: Projects Not Started

Project InfoProgramme Manager's Commentary

System Monitoring Solution - Implementation



Depending on the outcome of the INF107 project, this may be a procurement or an in-house build.

The project effort for this year is 50 days, but this is a multi-year project over three years.

This project will start in May.



Section Three: Projects in Progress



Project InfoProject Managers Commentary
INF105 (AP45-053)

Decommission Obsolete Infrastructure

Category: Core Funding



Milestones

09-Apr-2015Password Manager work completedBuild
10-Apr-2015TSM work completedBuild
07-May-2015Unix decommissioning (14-15) completedBuild
25-Jun-2015Windows decommissioning (14-15) completedBuild
02-Nov-2015Unix decommissioning (15-16) completedBuild
16-Nov-2015RedHat decommissioning (15-16) completedBuild
30-Nov-2015Recommendations and procedures signed offDeliver
07-Dec-2015Windows decommissioning (15-16) completedBuild
17-Dec-2015ClosureClose





RAG Status

GREEN

Report by David Watters for March 2015

Achievements this Period



  • TSM established and live in TEST environment
  • Work almost complete on setting up TSM in LIVE environment
  • First batch of obsolete servers (25) powered down and awaiting removal from network
  • Plans on next batch of servers being finalised
  • Work on migration to Password Manager continuing
  • Build of replacement SOA DEV environment completed

Issues



  • Deployment of TSM in LIVE taking longer than anticipated

Next Steps



  • TSM to be deployed in LIVE
  • Password Manager deployment to be completed
  • 'Priority 1' servers to be removed from network
  • 'Priority 2' decommissions to commence



INF107 (AP45-067)

Environment Monitoring System

Category: Core Funding



Milestones





29-Apr-2015Recommendation after Visits to Institutions
11-May-2015Closure





RAG Status

GREEN

Report by Maurice Franceschi for March 2015



All vists and demos for external and internals product completed. The team have started on final assessment, recommendation and report.

Achievements in Last Period

  • Visit Imperial and assess - done
  • Demo of Zenoss and assess - done
  • Demo of SCOM and assess - done
  • Assess potential of newRelic - done

Issues

  • one Amber risk - last reviewed early April

Next Steps

  • write report with recommentation for management

INF108 (AP45-034)

Automated Server Builds

Category: Discretionary



Milestones




03-Apr-20153rd Iteration
01-May-20154th Iteration
05-Jun-2015Recommendations
26-Jun-2015Closure











RAG Status

GREEN



Report by Colin Watt for March 2015



Achievements in Last Period

  • Puppet configuration has been implemented for Oracle TNSnames across all linux environments (2nd Iteration Milestone).
  • Puppet configuration tools have been used to deploy a pilot Python development environment (3rd Iteration Milestone), and has been provided to Dev Services for feedback.
  • PM and Senior Supplier have agreed with project Sponsor of TEL022 that the tools will be used to deploy the platform for the upgrade project.



Issues

  • Control of budget (PM and Senior supplier reviewing weekly and adjusting effort accordingly) to ensure sufficient effort is available to support TEL022.
  • Ensuring that timelines and resource availability are adjusted to align with TEL022 milestones.



Next Steps

  • The 3rd release will be to support provision of the platform for TEL022 Moodle Upgrade (an additional milestone will be planned for this release).
  • Review of milestones, project deliverables, and project timescale.

INF109 (AP45-033)

Annual upgrades of development tools (JIRA/Bamboo)

Category: Compliance



Milestones





Target dateTitle
16-Apr-2015Build and Acceptance Review - Bamboo
30-Apr-2015Delivery - Bamboo
07-May-2015Build Review - JIRA/JIRA Agile
14-May-2015Deployment Sign Off - Bamboo
28-May-2015Acceptance - JIRA/JIRA Agile
01-Jun-2015Delivery - JIRA/JIRA Agile
16-Jun-2015Deployment Sign Off - JIRA/JIRA Agile
26-Jun-2015Closure









RAG Status

GREEN





Report by Gillian Henderson for March 2015



Achievements in Last Period

  • Brief Signed off
  • Planning phase completed
  • Bookings requested in ASTA for all phases of project.
  • Dev tech bookings scheduled and assigned and for Bamboo and Jira Upgrades

Issues

  • Existing TADs out of date, in additional to adding minimal changes made by this project, these will need to be fixed to reflect current environment.



Next Steps

  • Initial upgrades on Bamboo and Jira to be completed for build phase
  • Testing of Bamboo upgrade.
  • Bamboo and Jira TADs moved to new template and updated.
  • Build sign off for Bamboo
  • Work on script change required for licensing issue with Jira





Section Four: Closed or Withdrawn Projects



Project InfoProject Managers Commentary

INF106 (AP45-032)

New Application Tier Replacement

Category: Compliance

Project closed on 6th February 2015.  Closure Report
