November 2014

Report Date
November 2014

Infrastructure Programme Report for Programme Owner David Smyth

Section One: Programme Commentary, RAG and Resources Update

Section Two: Projects Not Started

Section Three: Projects In Progress

Section Four: Closed or Withdrawn Projects

Section One: Programme Commentary, RAG and Resources Update

With the last project planned for calendar year 2014 now under way, the programme delivery and budget remains good. Only the small project for Annual Upgrade of Development Tools remains to start.

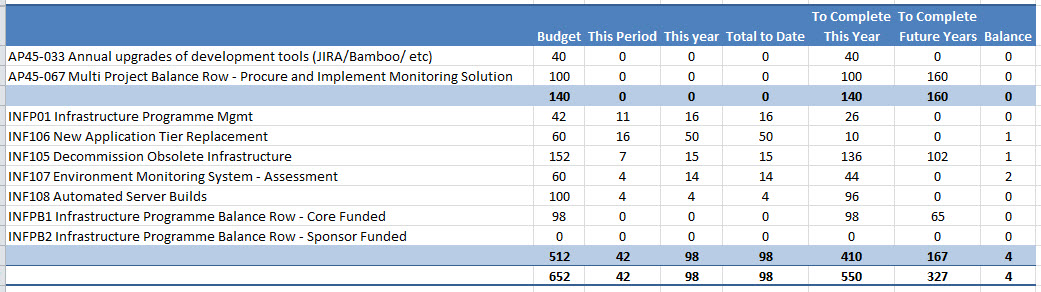

In fact, Programme Manager and Owner need to check that the burn rate on projects and the estimated effort will use up the planned budget - there is an possible opportunity of finding that we have more budget than we need to complete work this year. This wil be clearer by February.

There are a number of actions from the INF104 for the programme to progress. These are listed in a dedicated page. https://www.projects.ed.ac.uk/programmepage/30193

Programme Status is Green.

Section Two: Projects Not Started

Project InfoProgramme Manager's Commentary
Annual upgrades of development tools (JIRA, Bamboo, etc)

The Division has built up reliance on a number of key products over the years to assist in project and service delivery.

This project would apply relevant upgrades to the following products as required:

JIRA

JIRA Agile

Bamboo

ASTA

We will look to upgrade to latest stable and supported versions of the products above. This will not review new functionality and only concentrate on software upgrades.

Current feedback is that

There will be no ASTA Upgrade this year

The JIRA upgrades are not required until April.

Bamboo Upgrade will also start in April.

This project will now start in April.

Section Three: Projects in Progress

Project InfoProject Managers Commentary
INF105 (AP45-053)

Decommission Obsolete Infrastructure

Category: Core Funding

Milestones

05-Dec-2014Review of catalogue of obsolete infrastructureAnalyse
12-Dec-2014Further planning & estimation of subsequent stagesAnalyse
19-Dec-2014Planning (second phase) signed offAnalyse
27-May-2016Final DeliveryDeliver
01-Jul-2016ClosureClose

RAG Status

GREEN

Report by David Watters for November 2014

Achievements this Period

  • Project brief approved by WIS
  • Further meetings with business users to determine scope of catalogue and approach to planning
  • Further discussions round TSM work

Issues

  • Start of cataloguing task delayed (by a week) because of resourcing availability

Next Steps

  • Work to commence on cataloguing obsolete elements in infrastructure
  • Review of catalogue by project stakeholders
  • Planning of next stages of project to be drafted and agreed with stakeholders

INF106 (AP45-032)

New Application Tier Replacement

Category: Core Funding

Milestones

Target dateTitle
25-Nov-2014Acceptance Review
10-Dec-2014Delivery
19-Dec-2014Deployment Sign Off
19-Dec-2014Closure

RAG Status

GREEN

Report by Adam Wadee for November 2014

Achievements in Last Period

  • The test environments have been created and candidate applications migrated (Calmac and O365 landing page).
  • Applications have been DR tested and load tested successfully.
  • Acceptance review meeting held and approval given to progress to Live.
  • Live deployment and migrations scheduled for Wednesday 10th December.

Issues

  • None

Next Steps

  • Live deployment
  • Deployment sign off
  • Close project

INF107 (AP45-067)

Environment Monitoring System

Category: Core Funding

Milestones

10-Dec-2014Prepare Questions and Model Answers
09-Jan-2015Confirm Site Visits with other Institutions
30-Jan-2015Optional - Visit a fourth institution write up outcomes
30-Jan-2015Visit Three Institutions and write up outcomes
27-Feb-2015Recommendation after Visits to Institutions
13-Mar-2015Accepted Solution
27-Mar-2015Closure

RAG Status

GREEN

Report by Maurice Franceschi for November 2014

Achievements in Last Period

  • Complete Questions, Answers and Scenarios for Visits - not achieved. Not all the team have made their contributions yet.
  • Visit Sheffield in November - not achieved, but 16th december is confirmed
  • Visit Imperial by early December - unlikely - waiting to hear
  • Confirm third institution to visit by end of the Year - looking to visit Greenwich at same time as Imperial.

Issues

  • Two Amber risks - last reviewed mid-November - no change and still pertinent

Next Steps

  • Complete Questions, Answers and Scenarios for Visits
  • Visit Sheffield in December
  • Visit Imperial by end of January
  • Confirm third institution to visit by end of January

INF108 (AP45-034)

Automated Server Builds

Category: Discretionary

Milestones

Target dateTitle
05-Dec-2014End of Planning
05-Jun-2015Delivery
26-Jun-2015Closure

RAG Status

GREEN

Report by Colin Watt for November 2014

Achievements this period

  • Project website set up.
  • PM has had initial meetings with Project Sponsor, Business Lead, Senior Supplier, and ITI Unix.
  • PM has had a number of follow up meetings with Dev Tech who have already produced some documentation on preffered technical approach and architecture.
  • Project Brief created, subject to consensus by stakeholders and estimation for preferred technical approach.

Issues

  • 05 Dec was initially set as the date for the project brief, but this did not consider knock-on effect of Annual Planning on staff availability.
  • Involvement of ITI Unix is crucial to reaching agreement on the scope of the project and the brief; this was agreed on 11 Nov - but getting input has proved difficult and there has been no engagement with the brief.
  • PICCL submitted to WIS w/c 01 Dec for planning sign-off to be moved to 19 Dec (with agreement of Project Sponsor).

Next Steps

  • escalate ITI engagement issues with Project Sponsor and Business Lead
  • ensure Production Management fully engaged with proposal
  • agree project brief and submit to WIS w/c 15 Dec

Section Four: Closed or Withdrawn Projects

Project InfoProject Managers Commentary
No projects closed
