December 2013

Report Date
December 2013

Infrastructure Programme Report for Programme Owner David Smyth

Section One: Programme Commentary, RAG and Resources Update

Section Two: Projects Not Started

Section Three: Projects In Progress

Section Four: Closed or Withdrawn Projects



Section One: Programme Commentary, RAG and Resources Update

Additional budget has been found to allow the programme to fnd the Business Data Recovery proposal.

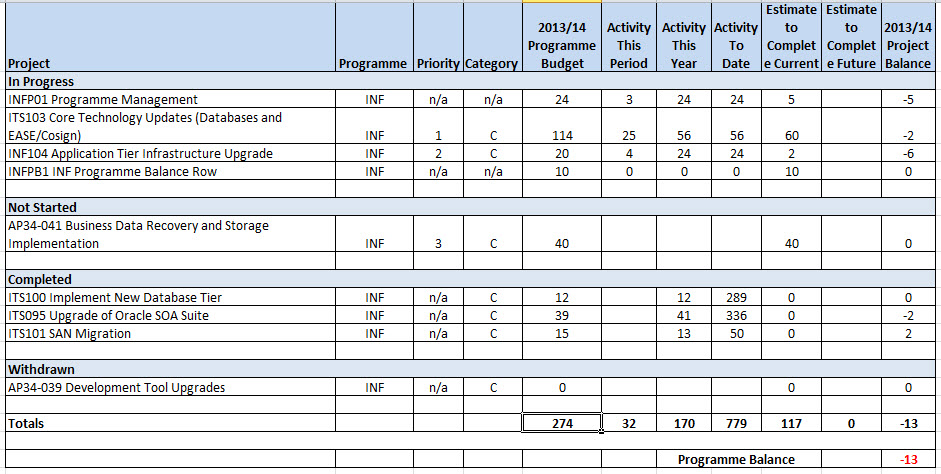

The projected total for the year has the programme running over by 13 days, but 10 of these are held in the balance row as contingency so we are still able to work towards a balanced budget.













 Section Two: Projects Not Started

Project InfoProgramme Manager's Commentary
AP34-041 Business Data Recovery and Storage Implementation



https://www.projects.ed.ac.uk/planning/project/140

This proposal will implement the findings of the review of data recovery and storage requirements for IS Applications as part of a wider review by ITI. The review will have outlined the requirements for storage of business data for disaster recovery/backup, archival and replication purposes. The necessary technical infrastructure will have been provisioned during 12/13 period as a result of the review and this proposal will bring the Applications service under the revised process and facilities.

Tony Weir will be developing the brief. The work is temporarily on hold due to conflicts with other priority work, but Tony has confirmed that it will happen in first half of 2014, and that it will be a procurement followed by an installation. The IS Apps effort involved for each project needs re-estimated. Currently this is a Small budget proposal.






Section Three: Projects in Progress



Project InfoProject Managers Commentary

ITS103 (AP34-038)

Core Technology Updates.

Category : C



Milestones



13-Jan-2014APPS Development Environment Complete
11-Feb-2014ASOR NEWSLIVE
13-Feb-2014Deploy NEWSLIVE
03-Mar-2014ASOR APPSLIVE
06-Mar-2014Deploy APPS LIVE
31-Mar-2014DSOR
07-Apr-2014Closure





RAG Status

GREEN



Report completed by Stevie Conlon for December 2013

Achievements This Period

  • APPS and NEWS Dev instances migrated to the new architecture . NEWS has been tested and signed off.
  • UCD is the favoured name for the new database instance and will contain BOXICMS, DIRECT and Calum McLean.
  • The planning milestones for each database have now been split out for each database to allow clearer project reporting.
  • An investigation was completed by Development into the feasibility of rewriting CRON jobs as part of the migration but the recommendation was that there were no quick fixes and it would be better to carry out any changes as a separate task.


Issues

  • A new project will be tasked with enhancing the performance of the SMART application, including moving the schema to the new database infrastructure. The SMART schema is currently in the APPS database which is being moved to the new DB infrastructure in March as part of the ITS103 project.  The enhancements to SMART are required before ITS103 delivers in March.It is proposed that the SMART enhancements project take over the tasks of creating the new database instances , currently code named UCD ,for DEV , TEST and LIVE and move the SMART schema in to the new instance from APPS to allow the SMART project to progress without any conflict or delay from ITS103. The ITS103 project will then migrate the schemas into UCD, namely Calum McLean, BOXICMS and DIRECT as previously planned. This will affect the planning and timescales budgets.



Next Steps

  • Continue to communicate with all user groups around dates for deployment.
  • Close off the APPS Dev environment.
  • Move the NEWS TEST environment to the new architecture.
  • Determine if any Development effort is required and estimate any impact on the project.
  • Work with the SACS PM, Franck Bergeret to determine scope,budget and timescales of the SMART enhancement project .

INF104 Application Infrastructure Upgrade Project

Category: Complience

Milestones

Target dateTitle
17-Jan-2014Delivery (Strategy Document Complete)
31-Jan-2014Closure



RAG Status

AMBER

Report completed by Adam Wadee for December 2013

Achievements in Last Period

  • The strategy document has been updated based on feedback from key stakeholders at the review meeting on the 5th December.  The revised version has been distributed to key stakeholders for review, with the aim of signing off by 17th Jan.
  • Along-with the review document, the project is also listing the applications residing on the solaris servers earmarked for moving to virtual infrastructure.  The project will ensure that an action plan has been agreed for all business applications needing migrated.

Issues

  • Additional effort needed to complete the strategy document.

Next Steps

  • Sign off strategy document.
  • Close project



RAG status Amber as additional effort required to complete the project.





















Section Four: Closed or Withdrawn Projects





Project InfoProject Managers Commentary

AP34-039

Development Tool Upgrades

Withdrawn on 30/8/13.

https://www.projects.ed.ac.uk/planning/project/141

This was due to impact on programme budget from carry over 12/13 projects.

However, we hope to be able to bring the project back into the 13/14 programme if budget, priority and new estimates allow.



The Division has built up reliance on a number of key products over the years to assist in project and service delivery.

This project would apply relevant upgrades to the following products:

JIRA

JIRA has fallen a few version behind latest version, so it may be this upgrade is required. Whether a proejct is required remain to be re-assessed.



Greenhopper

This is a small task to be done under APP004



Bamboo

This is a small task that should be covered by current Support arrangements.





ITS100

Implement New Database Tier

Report by David Watters

This project was closed on 13th September 2013

Please see the Completion Report for further information.



ITS101

SAN Migration

Report by Karen Stirling

This project was closed on 29th November 2013

Please see the Completion Report for further information.

ITS095

Upgrade of Oracle SOA Suite

Report by Stevie Conlon

The project was closed on the 7th November

Please see the Completion Report for further information.
