Report for August 2012

Report Date
August 2012
  •

Report compiled by Andy Stewart (IS Programme Manager) for David Smyth (Programme Owner)



Section One: Programme Commentary, RAG and Resources Update

Section Two: Projects Not Started

Section Three: Projects In Progress

Section Four: Closed or Withdrawn Projects

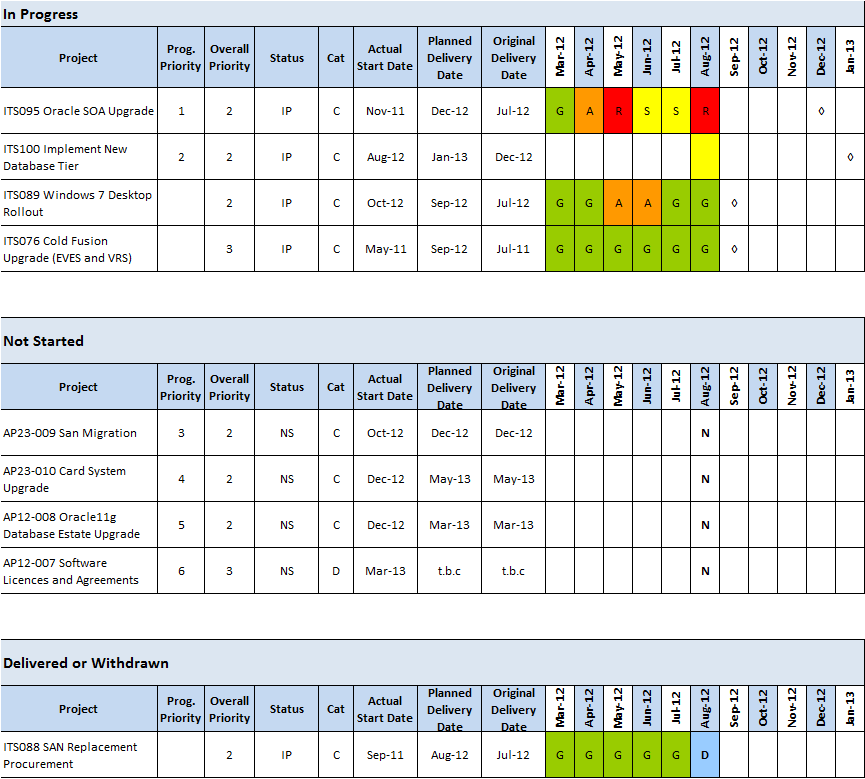

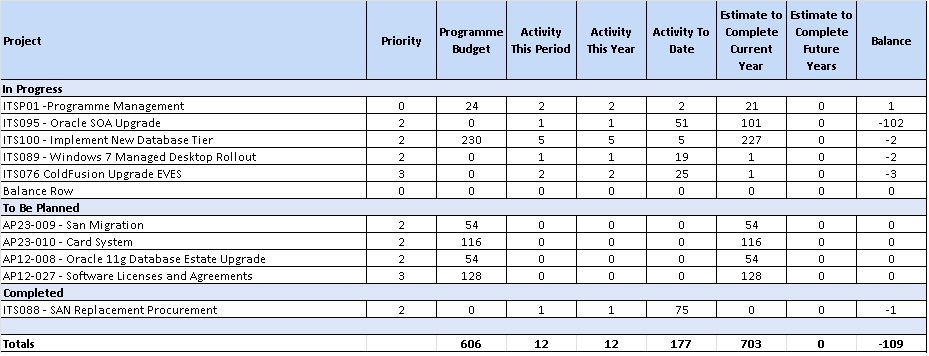

Section One: Programme Commentary, RAG and Resources Update



Work has been on-going with regards the projects carried over from 11/12, in that

  1. ITS088 - SAN Replacment Procurement has been closed
  2. ITS089 - Windows 7 managed Desktop is all but complete with the project closure meeting scheduled for 13th September
  3. ITS076 - ColdFusion 9 Upgrade for EVES has been deployed to the live production environment on 6th September and it is anticipated that the project will closed within the month

There is however a concern regarding ITS095 - SOA Upgrade as this project is still suspended due to lack of Development resource. Any delays in this project will have a serious impact on subsequent in-year projects looking to either undertake a SOA Upgrade or utilise SOA

Due to the unplanned carry -over from 11/12, the programme budget is currently in deficit and it is currently not possible to complete the programme for 12/13 with the current budget.  It is currently envisaged that the time scale for the project for the Sotware Licences and Agreements mananagement may require to be extended through into 12/13.  This will be discussed with the programme owner at the next programme meeting.



 Section Two: Projects Not Started





Project InfoProgramme Manager's Commentary

AP23-009

SAN Migration

Compliance

Planning October  2012

Delivery December  2012



RAG Status

 GREEN

Plan

Resulting from a meeting held with IS Apps and ITI Unix, it has become apparent that  one of the benefits of the recent SAN Procurement project is that the existing data stored on the 9985 disks will be able to be migrated onto the new SAN infrasatructure through mirroring whilst the application continues to function. As a result it is anticipated that this will be a shorter project than initially anticipated at the annual planning stage.

Once the initial process has been tested, the main objective of the project will be to plan and coordinate the data migration with the various business areas and the technical teams.

The progarmme manager will further discuss planning at the programme meeting with the programme and portfolio managers



Dependencies

Whilst there are no specific dependancies on this project, the technical view is that it would be preferable to migrate the data to the new SAN prior to the new database tier becoming operational

AP23-010

Card System Migration

Compliance

Planning December 2012

Delivery May 2013



RAG Status

GREEN

Plan

Commence the project late November to enable the planning phase to be completed before the Christmas holidays



Dependencies

Coordination will be required with Card System changes associated with Distance Learning

It should also be noted that all functional requirements and testing is currently coordinated through one individual in Card Services

AP12-008

Oracle 11g Database Estate Upgrade

Compliance

Planning January 2013

Delivery March 2013



RAG Status

GREEN

Plan

This remaining databases associated with this project relate to the follwoing two databases; IDM - The project manger will consult with programme owner of the Communications programme to ascertain if the database upgrade could be incorporated into the project 'Migrating IDM to Oracle SOA Suite 11g'.  If acceptable, arrangements will be made to transfer 50% of the budget, namely 27 days to Communications programme.

ERI



 Dependencies

Requirement to contact the supplier InfoEd to determine the if the current application supports Oracle 11g

  AP12-027

Software Licences and Agreements Management

Compliance

Planning March 2013

Delivery October 2013



RAG Status

RED

Plan

Due to current budget limitations it will not be possible to complete this project this year and as a result will be started end of the 3rd quarter and will require to be carried forward into 13/14



Dependencies

Sufficient budget to complete required project development



Section Three: Projects in Progress





Project InfoProject Managers Commentary

ITS076 (AP number)

ColdFusion Upgrade - EVES



Category:Compliance



Milestones

-

Target dateTitle
06-Sep-2012Deployment
12-Sep-2012Deployment Sign Off Review
19-Sep-2012Closure

RAG Status

GREEN



Report by David Watters for August 2012

Achievements in Last Period

 The issues regarding the test logins for the nominated staff were resolved to enable testing to progress

  1. Testing was successfully completed by EUSA staff for both the public facing and admin site
  2. The ASOR meeting was held on 31st August resulting in approval for deployment on Thursday 6th September.
  3. Approval for deployment was given by the specialcab

Issues

 None

Next Steps

  1.  Deployment to live on Thursday 6th September.  For information, whilst comiling the report, the deployment to live has been completed as scheduled
  2. DSOR is schuled for 12th September
  3. Prepare project completion report
  4. Closure is scheduled for 19th September





ITS089  (AP12-904)

Win 7 Managed Desktop Rollout



Category:Compliance

Milestones



Target dateTitle
13-Sep-2012Closure

RAG Status

GREEN

Report by Andrew Stewart for August 2012

Achievements in Last Period

During the month, work has been on-going with roll-out in phase 3

With regards phase 3 (Schools without computing officers) (i) The rollout has continued during this month (ii) The current status can be viewed on the wiki (iii) The latest details from the wiki can be summarised as follows (iv) USD have advised that any remaining pc's after mid-September  will be dealt with by IS helpline



College / SchoolTotal PC's IdentifiedTotal PC's UpdatedRemaining PC's
HSS
Divinity75750
Health in Social Sciences50455
History, Classics and Archaeology89845
LLC Confucius Institute12120
School of Education1397763
OLL42411
MVM
Central876225
Little France20884124
Western General605010
CSE
College Office35350
Centre for Science at Extreme Conditionsto be confirmed





Issues

 None

Next Steps

 Closure meeting is scheduled for 13th September



ITS095  (AP12-031)

Upgrade of Oracle SOA Suite



Category:Discretionary

Milestones

N/A

RAG Status

RED

Report by Stevie Conlon  for August 2012

Achievements in Last Period

The project remains suspended

Issues

It has not been possible to secure any resource from Development to commence the system desigh

Next Steps

Project remains suspended due to unavailablity of Development resource. Further discussions to be held with Development Team.



ITS099  (AP12-008)

EUPS Databases Upgrade

Category: Compliance

Milestones

N/A

RAG Status

RED



Report by Stevie Conlon for August 2012

Achievements in Last Period

The project has not yet started due to time spent by the PM on other deployments

Issues

Other work of a higher priority, namely ITS098 Polopoly Database Upgrade,  has hampered any progress.

Next Steps





 Plan in project kick-off as ITS098 now deployed.











ITS100  (AP23-008)

EUPS Databases Upgrade

Category: Compliance

Milestones



Target dateTitle
03-Oct-2012Business & System Analysis sign-off
03-Dec-2012Build sign-off
18-Dec-2012Acceptance Sign Off
30-Jan-2013Deployment Sign Off
07-Feb-2013Project closure approved

RAG Status

AMBER

Report by David Watters for August 2012

Achievements in Last Period

 During this period,

  1. As a result of a series of meetings the project brief has been produced and circulated
  2. An initial top level project plan has been created
  3. An estimation meeting has been held and circulated to the members of the project team

Issues

 During the estimation process a number of questions have arisen regarding the patching strategy requirements / deliverables within the project..  Due to holidays and diary conflicts it has been possible to clarify these matters with the project sponsor and as aresult, the planning phase has been unexpectedly delayed.   A meeting has now been arranged for Friday 7th September.

Next Steps

  1. Complete and sign-off the brief and any revised estimate
  2. Prepare a more detailed project plan
  3. Commence the business analysis phase of the project





Section Four: Closed or Withdrawn Projects





Project InfoProject Managers Commentary



Project Code:  AP12-907

Project Title:  New SAN Infrastructure Procurement



Discretionary

Report by Andrew Stewart

This project was closed on 24-08-12

Please see the Completion Report for further information
