April 2013

Report Date
April 2013



Report compiled by Maurice Franceschi (IS Apps Programme Manager) for Jared Taylor  (Programme Owner)

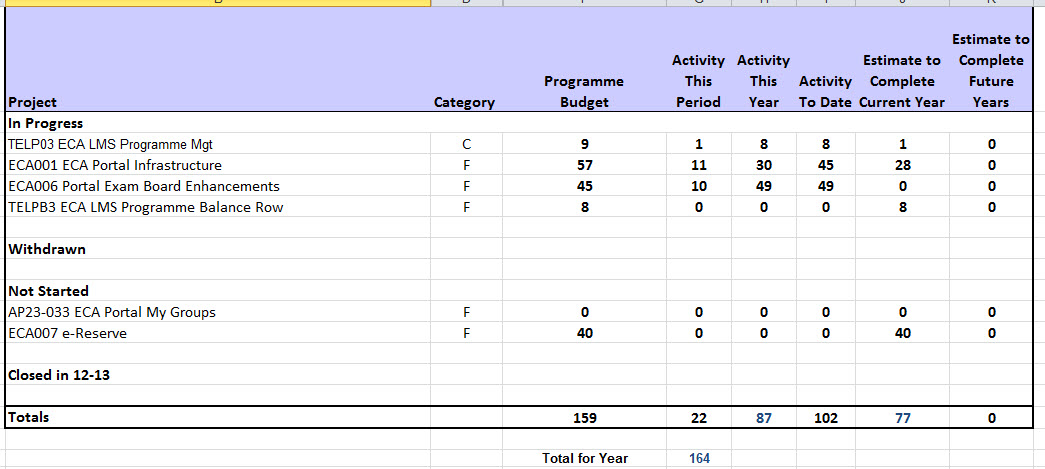

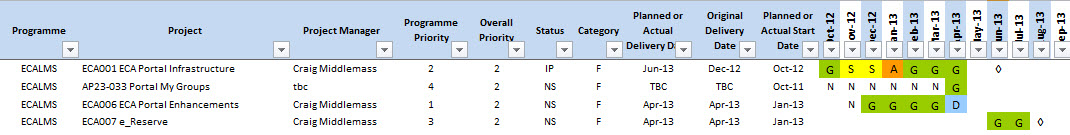

Section One: Programme Commentary, RAG and Resources Update

Section Two: Projects Not Started

Section Three: Projects In Progress

Section Four: Closed or Withdrawn Projects





Section One: Programme Commentary, RAG and Resources Update



ECA006 Exam Board Enhancements has delivered.

ECA001 Infrastructure wil be delayed as the planned upgrade conflicted with examinations.

Also, a new in-year project ECA007 is needed to address a serious audit issue the portal has with copyrighted material. This aims to delvier by start of term.

ECA have also confirmed they are ready to commit effort and budget to a project to move ECA to SMART, however as HSS are unikley to match funding on a 50/50 basis this remains unlikely for 13/14.

With 8 days in teh balance row, all planned effort is within programme budget.



Actions from programme meeting















 Section Two: Projects Not Started

Project InfoProgramme Manager's Commentary

AP23-033

ECA Portal My Groups ECA Ring-Fenced

Milestones

TBC



RAG Status AMBER

Plan Other work has risen in priority which probably lead to this proposal being descoped. It wil be reviewed once Infrastructure Project and in context of other enhancements required.

Proposal and Estimates



Dependencies None

AP23-TBC

e-Reserve ECA Ring-Fenced

Milestones

TBC



RAG Status AMBER

Plan This is a new in-year project to be started asap, to resolve an issue with copyright on the portal.

Proposal and Estimates



Dependencies ECA001 project to complete first.





Section Three: Projects in Progress

Project InfoProject Managers Commentary

ECA001

ECA Portal Infrastructure

Category: Essential

Milestones



17-May-2013Peer Test Sign Off
04-Jul-2013User Acceptance Test Sign Off
08-Jul-2013Deploy to Live
15-Jul-2013Deployment Sign Off Review
17-Jul-2013Closure


RAG Status

GREEN

Report by Craig Middlemas for April 2013

Achievements in Last Period

  • The Business Requirements has been signed off
  • The Design is ready for sign off in early May
  • Build of Dev environment is almost complete

Issues

  • The timing for the go live may need to move given the availability of staff and the need to avoid infrastructure moves while exam boards are still on (last board 24 June)

Next Steps

  • Sign off the system design
  • Complete Peer Testing
  • Handover to ECA for User Acceptance Testing



ECA006

ECA Exam Board Enhancements

Category: Discretionary



Milestones

31-May-2013Deployment Sign Off
07-Jun-2013Close



RAG Status

BLUE

Report by Craig Middlemas for April 2013

Achievements in Last Period

  • Testing completed and signed off
  • Deployment to live complete, including a last minute change to one of the grade calculations

Issues

  • Agreement reached to extend project closure until after the exam boards are complete

Next Steps

  • Deployment sign off review
  • Close the project







Section Four: Projects Closed / Withdrawn



Project InfoProject Managers Commentary






Actions from January Programme Meeting (21st February)

Final Clarification for Exam Board EnhancementsClair to clarify asap to John and CraigDone
Decide on priority between Additional Enhancements and MyGroupsAdditional Enhancements is prioritised. However, we may start both projects to ensure we use all the allocation of days in 12/13Done
ECA to decide who else is to own the programme with JaredECA to confirm
Additional Enhancements Scope Craig to work with ECA on defining these for end of March
13/14 PlanningConsider other work for next year CAM to confirm asap
SMARTMaurice to work with HSS to see if they will fund a medium size project on a 50% basis



Actions from October Programme Meeting (5th November)

There is a significant bug around session ids and opening the portal in more than one tab leadig to data loss on forms

Jared to raise a UniDesk Call

Craig wil check on reponse and If too big for a support fix, then add to project


Three Enhancements pending for deploymentJared to ask Olwyn to check fixes in TEST and confirm to Craigso he can deploy to LIVE
I/F project - no dev resource until January Environments bening builtCraig to plan build and testing to be completed for delivery at end of March to avoid May-June period for ECADone
Olwen Enhancements Project - get ready up front for developer availability in March - AprilMaurice to start up project so we can get a requirements spec agreed by February, with estimated and prioritised requirements, so build can start right after portDone
Further Enhancements project

Jared to start compiling a list of further enhancements



Jared to confirm the scope (Descope) of the MyGroups project so we can estimate effort for that project - and Olwen enhancements - and see what is left to do more in this year.

Done
Annual Planning 13/14Jared to review list from last year and select one or two - or add new oneDone
StrategyJared states that a stable environment for medium term of 3-4 years is our aim, even if the Portal stays static in terms of further development.Done



Actions from August Programme Meeting (19th Sept)

) Craig to pick up Infrastructure project - if not possible Maurice to get another project manager. Right away.Craig MauriceDone - Craig is PM

Jared will work with colleagues on an analysis of the portal content and triage content that is not being updated content that resides on the university website - remove from Portal? Or link from Portal?

Content that is best kept in the portal



And where from Website do we link back to portal, and consider a MyED launcher



And ECA to commit to maintianing the portal



I think that if at the end of the exercise ECA could articulate their vision for the portal in the medium term ... more than an VLE, just a VLE, the main resource from where students start ... it would help

Jared ECADone

Craig to organise an estimation meeting with John A. so we can get a rough budget for the enhancements for the board : project to eb set up with delivery date April

CraigDone

Need to chunk up the My Groups requirements and focus on the highest priority - List of Groups for example. After 1) and 2) and 3) are done, then whatever budget is left will be prioritised for My Groups. Do we already have this requirements/task breakdown?

JaredDone
