Report compiled by Chris Lawford (Programme Manager) for Alex Carter (Programme Owner)
Section One: Programme Commentary, RAG and Resources Update
Programme Commentary
Key Achievements in Last Period
- Business Reporting and Analytics Service Enhancements project in progress.
- Procurement of Qlikview / Qliksense licences in progress.
Top Three issues
- A change of programme manager occurred at the end of April. The new Programme manager is in the process of getting to up to speed with the programme, and divesting his existing workload. As a first step, a review of the programme vision, blueprint, project deliverables and budget is underway. This has inevitably caused some disruption within the programme.
- Ensure that the Qlikview Consolidation reaches a satisfactory conclusion. We must ensure that the project is compliant from both an IS and procurement perspective. A new PM has been appointed to take the project through to completion.
- The scope and nature of projects “DTI031 - Developing the BI Community” and DTI036 “Reporting Data Models” are unclear and are currently on hold. There have been a number of recent discussions and the results of these need to be reviewed before we go forward.
Key Next Steps
- Conduct Programme review and ensure all elements are within governance and compliant.
- Complete negotiation of Qlik licences and reach award.
- Commence planning for Qlik implementation
- Agree scope and nature of community and reporting projects.
Overall, given the uncertainties, the programme is rated at AMBER. I expect a more informed picture to emerge over the next month.
Status and Forward Look
For security reasons, images aren't duplicated during cloning. Please re-add or replace the image as required.
(Not supplied for April)

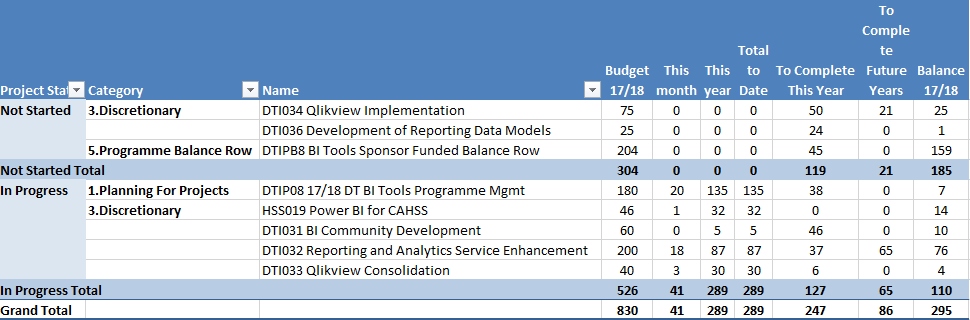

Resource Summary

Section Two: Projects Not Started
| Project Info | Project Manager's Commentary | |
|---|---|---|
| Qlikview Implementation | Planned Start May-18 | |
| Enterprise Reporting Data Model | Planned to start March-18 | |
| Operational Reporting Requirements Analysis | Planned to start Aug-18 |
Section Three: Projects in Progress
| Project Info |
Project Manager's Commentary |
|||||||||
|
HSS019- Power BI Gateway Service
Discretionary Milestones 19-Sep-2017 Project Initation 06-Oct-2017 Planning Complete 01-Dec-2017 Business Analysis 08-Dec-2017 System Analysis 15-Dec-2017 Build Complete 11-Jan-2018 Integration Testing Complete 22-Jan-2018 Acceptance Complete 29-Jan-2018 Deploy To Live 06-Apr-2018 Data Source Configuration 20-Apr-2018 Project Closure RAG Amber |
Report by Geoff Cropley for April 2018 Achievements this periodA change request has been raised to add an additional milestone and to extend the project closure milestone. Additional Milestone: During project execution it became clear that there was additional complexity in the development and use of dashbaords with Power BI Gateway. This is in part with the use of new technology where in-house skills are developing. In addition, the business analysis did not identify completely how the existing tactical service was configured. The tactical gateway had been configured in a way that is not designed for. The impact of the new requirements represent a scope change and the need to create a new milestone to accommodate the additional work required to complete the project. The milestone includes resolving database configuration issues and additional server and client implementations required to support access to data connections, the gateway and user credentials. Closure Extension: With the addition of the above milestone and the result of industrial action it is necessary to extend the project closure milestone. The impact of the industrial action was the unavailability of key personnel. The scope has increased to include additional client and server database components, Additional firewall rules changes and database credential additions.
The resource we need has been participating in industrial action and has now been secured. There is still the risk of future industrial action delaying the project. IssuesNone
Next StepsComplete security and access tasks and close project.
|
|||||||||
|
DTI031 - Develop the BI Community
Discretionary Milestones 02-Feb-2018 Exit Planning 14-Jul-2018 Project Delivery 28-Jul-2018 Project Closure RAG Amber |
Report by Chris Lawford for April 2018 No change to status It is proposed to review this project in its current form. The community engagement will be picked up as part of the overall programme benefits realisation effort. Specific tasks will be included in proposed BI accessibility and usability projects which are currently being defined. Achievements this period
Issues
Next Steps
The project is reporting a status of AMBER
|
|||||||||
|
DTI032 - Business Reporting and Analytics Service Enhancements
Discretionary Milestones 16-Mar-2018 End of Planning 23-Mar-2018 Service Enhancement Review 21-Apr-2018 Target Operating Model 27-Apr-2018 Small Change Process 18-May-2018 Security Policy Review 31-May-2018 End User Training Review 15-Jun-2018 Project Closure RAG Green |
Report by Geoff Cropley for April 2018 Achievements this periodService Review, Target Operating and Security streams have completed. IssuesNone Next StepsContinue delivery to agreed milestones. |
|||||||||
|
DTI033 - Qlikview Consolidation
Discretionary Milestones 26-Jan-2018 Exit Planning 09-Feb-2018 Issue Requirements to the Vendor 09-Mar-2018 Issue Purchase Order 16-Mar-2018 Project Completion 30-Mar-2018 Project Closure
RAG Amber |
Report by Chris Lawford for April 2018 Achievements in last period
Issues
Next Steps
The project will report until report AMBER until the status of the project is better understood, and project returns to governance. |
Section Four: Closed or Withdrawn Projects
None
